Evidence Based Planning

#EvidencePlan #EstimatesAreBS
slides.com/scottconnerly - more talks


A Practical Guide to #NoEstimates

Pre-req: Great Product & BA Team

  • Stakeholder requests a feature, provides a brief if we’re lucky.
  • Level 0 (L0) Estimate: Based on our meager understanding, we find similar shaped features in our past, note their L0 guesses.
  • Product team does all their Envisioning, Definition, & Translation phases to turn the request into workable tickets.
  • We count those tickets and kick off development.

A Perfect Storm of Needs

  • Sales need dates
  • Managers need staffing plans
  • Project managers need to assign epics to teams
  • Devs need room to dream, brainstorm, and solve problems

Look for

  • The word “and”
  • A list? Bullets? Commas?
  • Tech Debt pre-req? “Make the change easy, then make the easy change.”
  • Multiple major data models. Scope epics as if you’re designing for a microservice system, even if you aren’t.
  • System actions downstream of user actions.



Build a list of historical gotchas

  • Empty states
  • Loading states
  • Error handling for every user event
  • Handling legacy data
  • Timezone & DST considerations
  • Deployment considerations
  • etc



Example 13-point ticket from a snail mail mail-merge epic from 2014






“Label size & repetition handling”



Several 1-point tickets

  • Establish Avery label size ENUM for FE
  • Layout label size selection dropdown on create/edit views
  • Enable label size selection dropdown on create/edit views
  • Display error if no size selected
  • Write migration to add label size field to `mailing_label` table
  • Establish Avery label size ENUM for BE
  • Add label size to MailingLabel model (property, getter, setter, update)
  • Return label size in mailing label REST responses
  • Display label size in mailings list view
  • Calculate number of pages based on recipient list and sheet capacity
  • Layout label contents of recipient name and address
  • Select fittable font size based on line length and label size
  • Loop through pages that loop through labels



???

COUNTING

JIRA Cloud Azure DevOps Web CSV
Excel =JIRA() ADO Open in Excel Data > From Web
Sheets =JIRA() Zapier? Automate.io? =IMPORTDATA()

Evidence

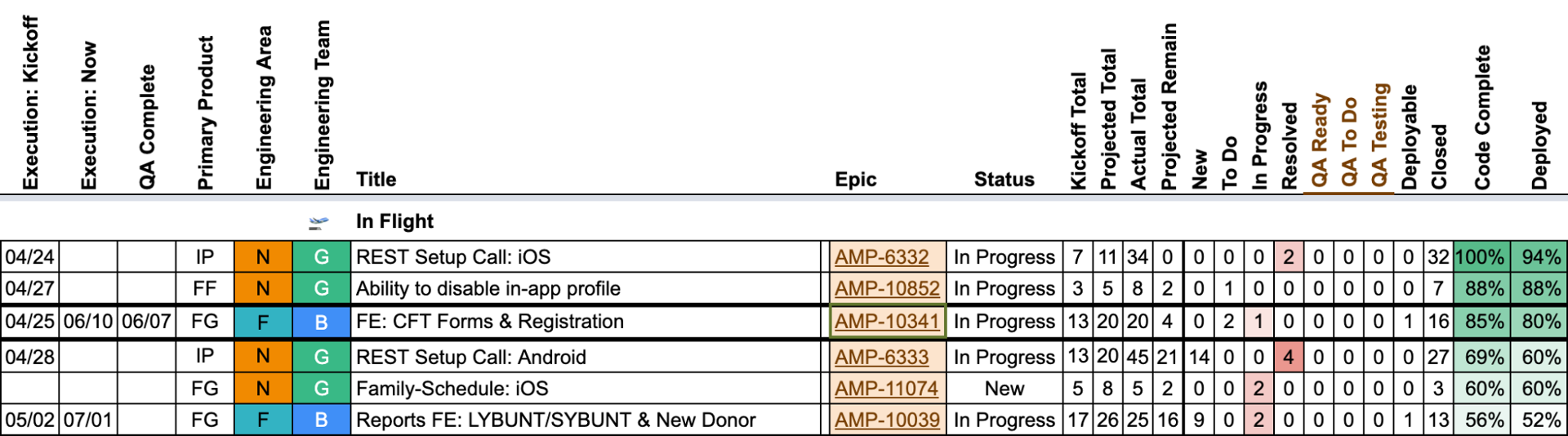

  • Epic burndown stuff
    • Kickoff total / Current total
    • Remaining count

Evidence

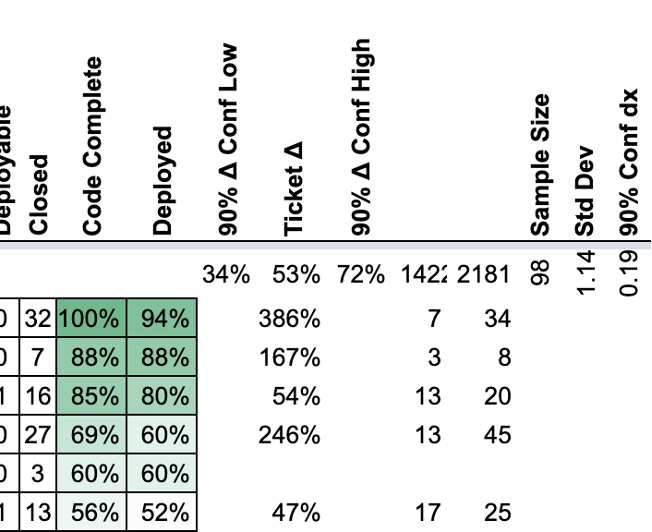

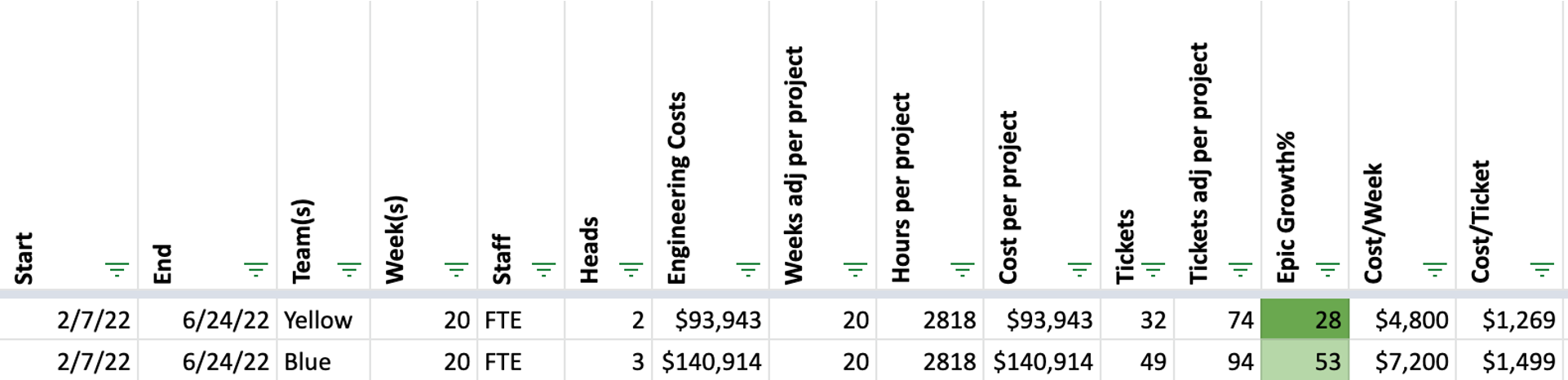

  • Track the epic growth rate (53% currently)
    • Standard deviation of growth (1.14)
    • Confidence interval of growth (34%-72%)

Evidence

  • Dynamic epic size projections
    • Projected total (kickoff * average growth)
    • Projected remaining (remaining * average growth)

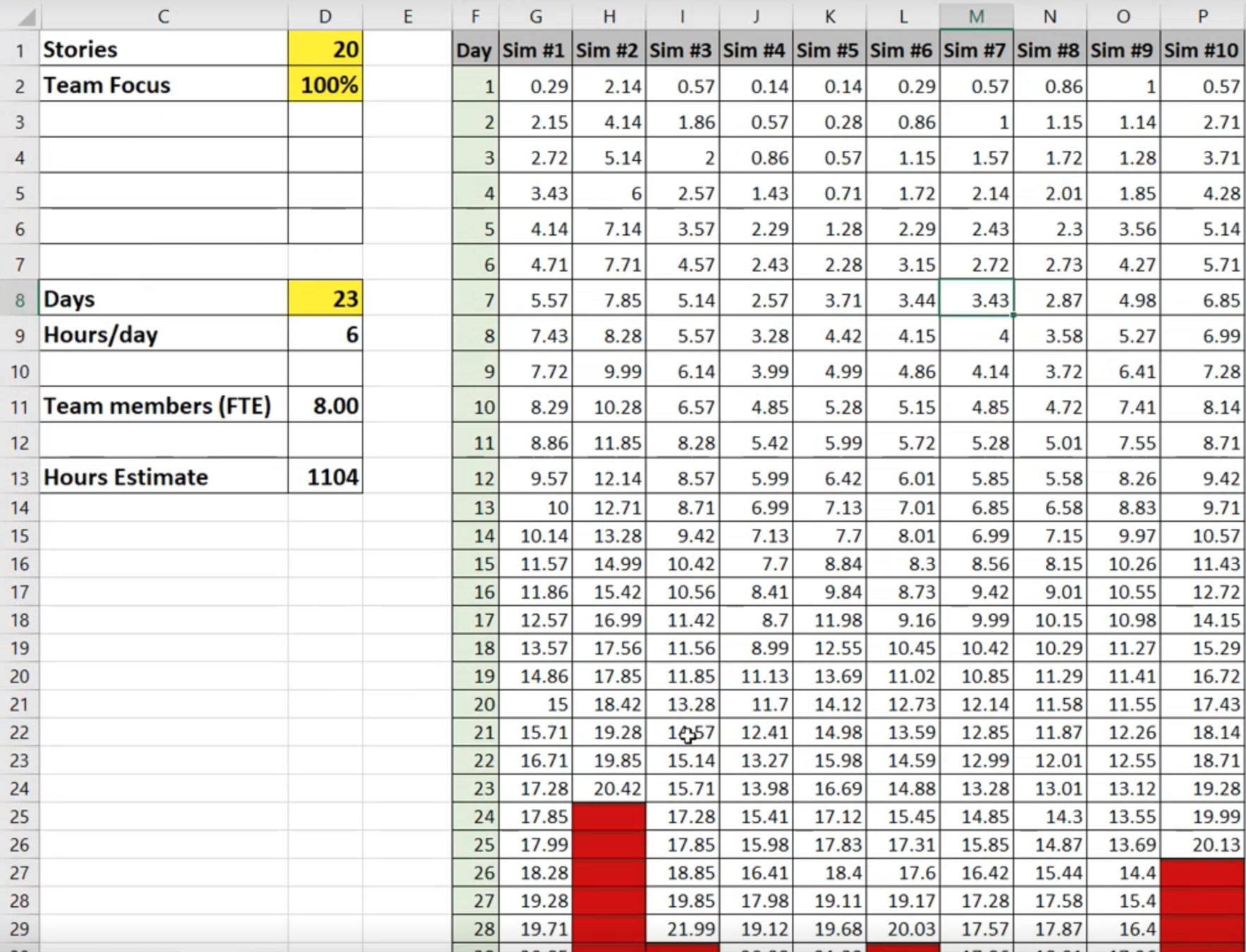

Evidence

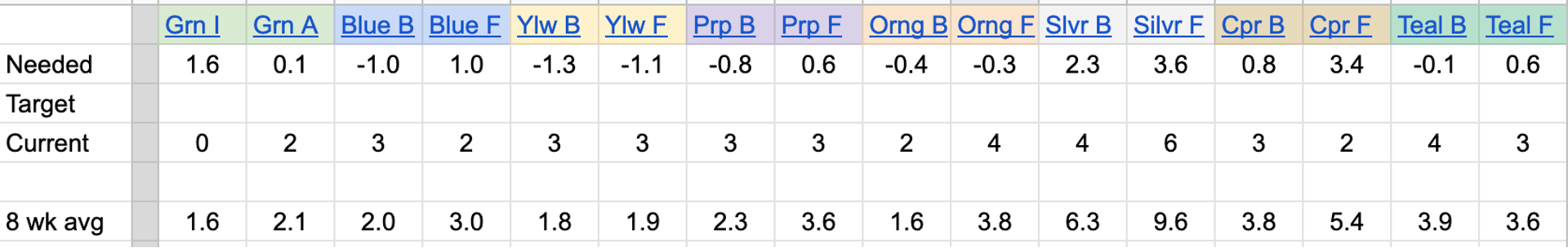

  • Team’s 8wk average Epic ticket resolution rate

Evidence

  • Epic date projection
    • Today + Projected remaining / Team’s 8wk average

Evidence

Epic ticket count

x Average epic growth rate

= Ticket projections


Ticket projections
÷ Team’s 8wk average Epic ticket resolution rate
= Epic date projection



Updating the Projection

Update the the date projection weekly.

As you hit development thresholds, communicate updated date projections to stakeholders:

  • At 10% complete, call it a “Level 1” projection
  • At 50% complete, call it an “L2” projection
  • At 90% complete, call it an “L3” projection





Evidence Based Planning

By Scott Connerly
