ATCN Planning for HGTD
Towards Phase II


HGTD Coordination Meeting - 10.04.2024 - Gustavo Uribe




| Location | # Switches |
|---|---|
| USA15 | 3 |
| US15 | 0 |
| SDX1 | 0 |
| UX15 | 0 |
Count of switches in primary locations
The number of switches assigned is based on the HGTD network requirements gathered.
Switches for FELIX are not included here and are included in TDAQ counting only.
HGTD Coordination Meeting - 10.04.2024 - Gustavo Uribe



The switches are not in ACES.
- I have proposed to use the four bottom units for the network on racks Y.22-14.A1, Y.23-14.A1 and Y.25-14.A1. Is it acceptable?
- Two fibre patch panels are located in HGTD racks. One in Y.23-14.A1 and the other in Y.22-07.A1. Could we keep them on these locations? Move them in not trivial but possible.
HGTD Coordination Meeting - 10.04.2024 - Gustavo Uribe




HGTD Coordination Meeting - 10.04.2024 - Gustavo Uribe



Summary of Activities for HGTD
| Activity | Starting | Ending |
|---|---|---|
| Deployment of new network switches for HGTD, ITK, TC and ZDC (USA15 level 1) | 25/May/27 | 05/31/2027 |
HGTD Coordination Meeting - 10.04.2024 - Gustavo Uribe



JIRA ticket for Offline Discussion
There is a JIRA ticket created for discussion. The tickets is named:
| Consolidate the network distribution of the HGTD switches |
HGTD Coordination Meeting - 10.04.2024 - Gustavo Uribe

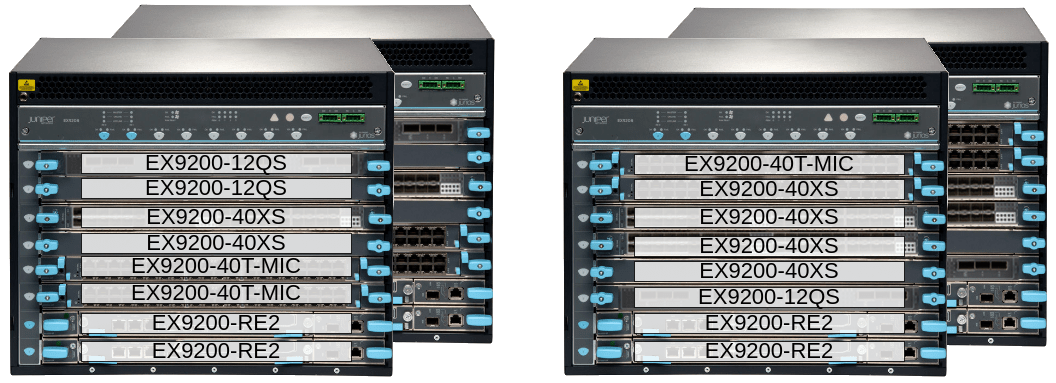

Routers Phase II

100G 4/8
10G 268/320
1G 0/80
The router's maintenance period is not yet scheduled. It's expected to happen in the shadow of the DSS upgrade. The duration will depend on the final chassis selected, ranging from 2 to 5 days.
HGTD Coordination Meeting - 10.04.2024 - Gustavo Uribe



Thanks!



How to use the planning page?

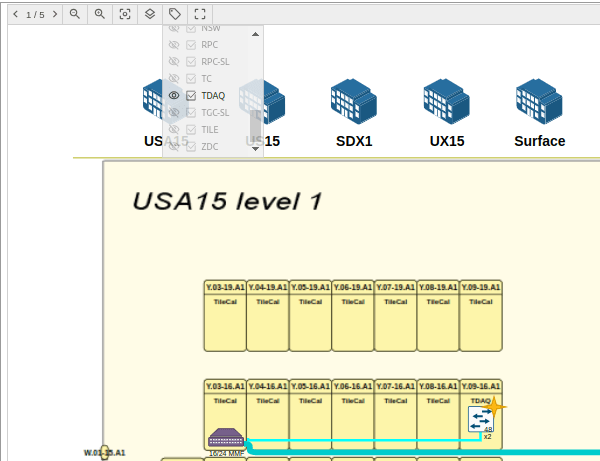

1. Select the subsystem that you are intereseted
HGTD Coordination Meeting - 10.04.2024 - Gustavo Uribe



How to use the planning page?

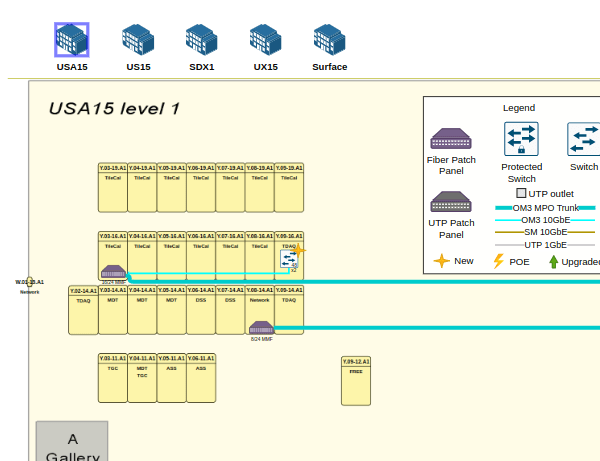

2. Select the interested building

HGTD Coordination Meeting - 10.04.2024 - Gustavo Uribe



How to use the planning page?

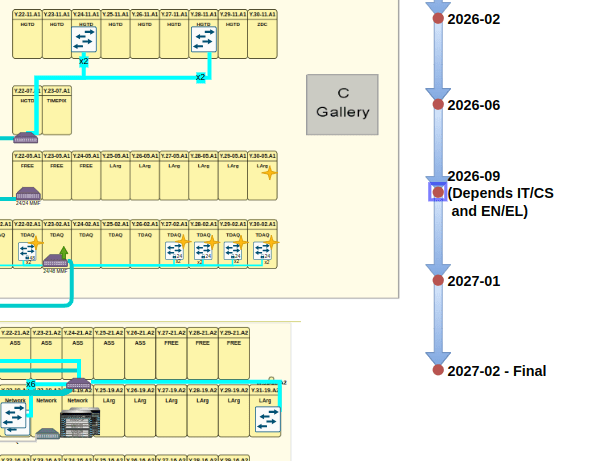

3. Use the flow diagram in the right side to see the stages of the network in different dates.

On each date, new elements are marked with a yellow star, removal with a red mark and upgraded elements with a green arrow.
HGTD Coordination Meeting - 10.04.2024 - Gustavo Uribe



How to use the planning page?

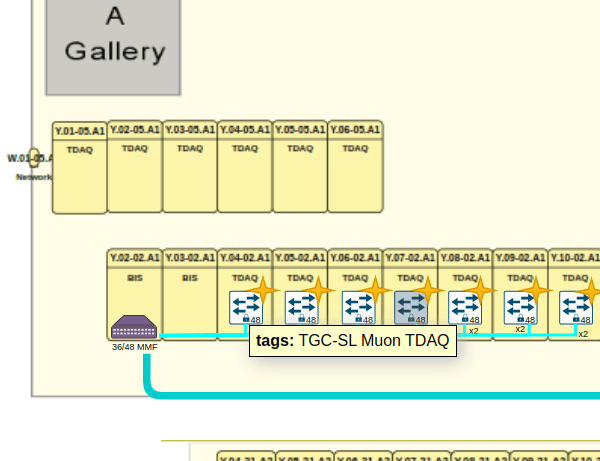

4. Hover the mouse over the elements to see subsystems or comments.

HGTD Coordination Meeting - 10.04.2024 - Gustavo Uribe
ATCN Planning for ITK
By Gustavo Andrés Uribe Gómez
ATCN Planning for ITK
- 153
