Meg Houston
Product Manager
1.19.16 - 2.1.16

We did not make our sprint commitment. We completed 4 out of 9 committed points.
We tried to tackle too much in this sprint and fell behind due to a few reasons: Kickoff prep meetings, an underestimated story, and some unforeseen PTO.
We completed most of the code on our stories, but didn't finish the testing on 2 of them.
We know this was not our best sprint.
Our plan going forward is to reassess the sprint again
(right after sprint planning)
and take things out if it looks too aggressive again.

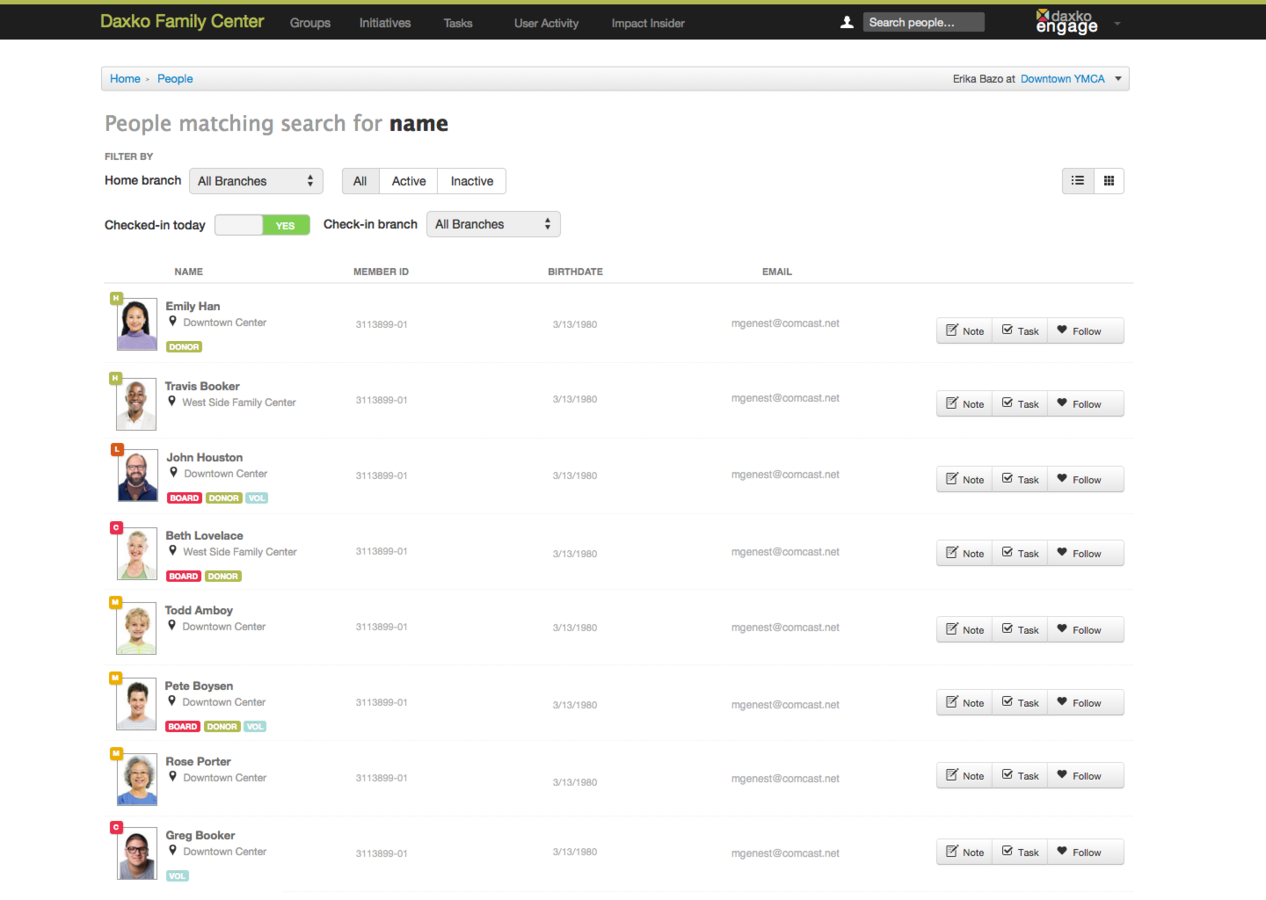

We converted the search results page to Javascript and added filtering options.
We also removed Daxko Insight from Engage and worked on some bugs.
We changed the organization of the page, surfaced more data about each member, and added quick action buttons.
*The red arrows were code complete, but not fully tested. This is why we didn't make our commitment.
Our goal is to make considerable progress on the data warehouse work.
Bryan H is working with the devs to execute on a list of changes.
We also plan to spike
Erika + Meg have 3 customer calls lined up, and a design workshop for the team on Friday.
By Meg Houston
