nic scott

Telescope Systems Scientist

Current state of CHARA telescopes & Future plans

The CHARA Science Meeting 2025 - Nice

Telescopes & Future plans

1

but let's assume the best...

2

Telescopes & Future plans

Where does CHARA have single point failures....

i.e. where the nightmares lie?

  • aging equipment
  • time sinks
  • lack of spares
  • discontinued components
  • supply chains becoming questionable
  • other risks

4

  • Mirror recoats
  • W1 M5 damage
  • Winch system
  • New drives

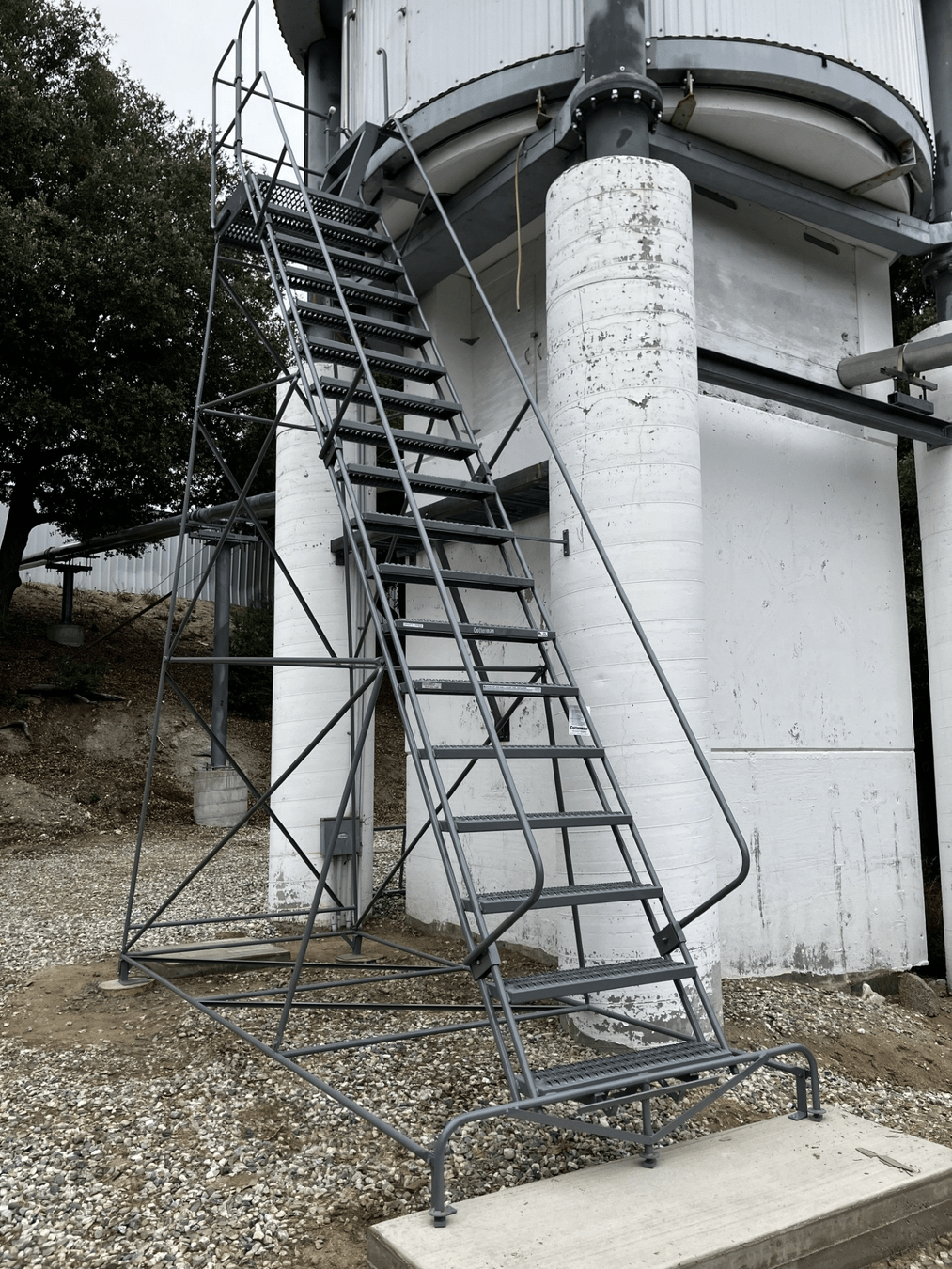

  • Stairs & weatherstripping & minions
  • Cylinder control
  • W1 realignment
  • AOB problems and plan for new system
  • Tiptilt concerns
  • Future

3

Telescopes & Future plans

Mirror recoats

scope date last done tbd
S1 4-2022 2026
S2 8-2021 2026
W1 2-2025 2027
W2 9-2019 2025
E1 12-2024 2027
E2 1-2018 2025

5

Telescopes & Future plans

Telescopes & Future plans

2

6

  • W1 M5 fracture
    • internal mirror stress
    • cross polarization test
  • Replaced with flat M4 -lucky
    • no spare M6 or M2
    • have a matched M1/M2 spare
  • Chamber is no longer flat
    • teflon standoffs
  • Chamber seal
  • Want a small chamber for individual mirror recoats

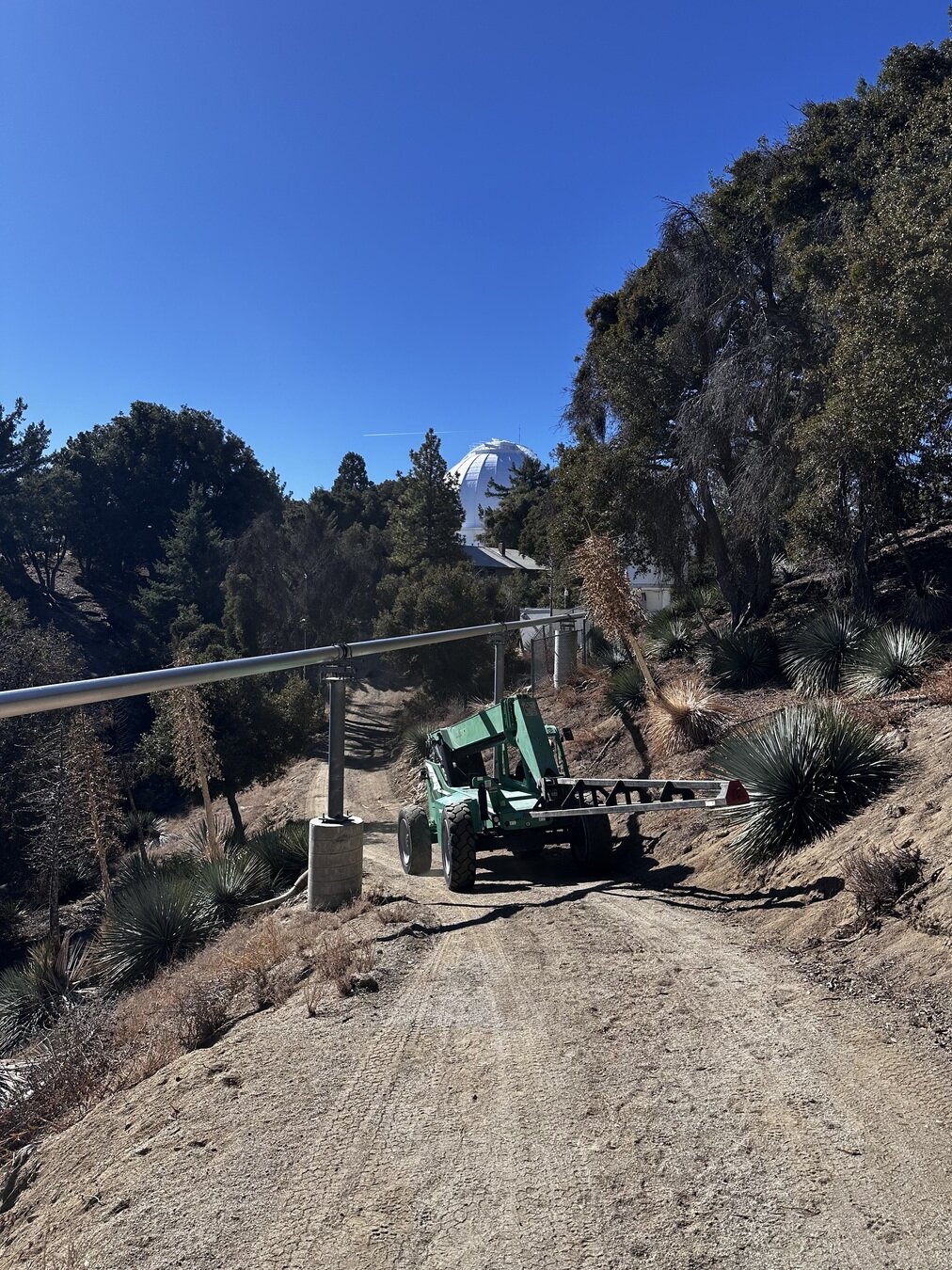

  • Boom truck
    • Genie/rental stop gap
    • new hoist system
    • needed for AZ drive

7

Telescopes & Future plans

8

Telescopes & Future plans

W2 & E2

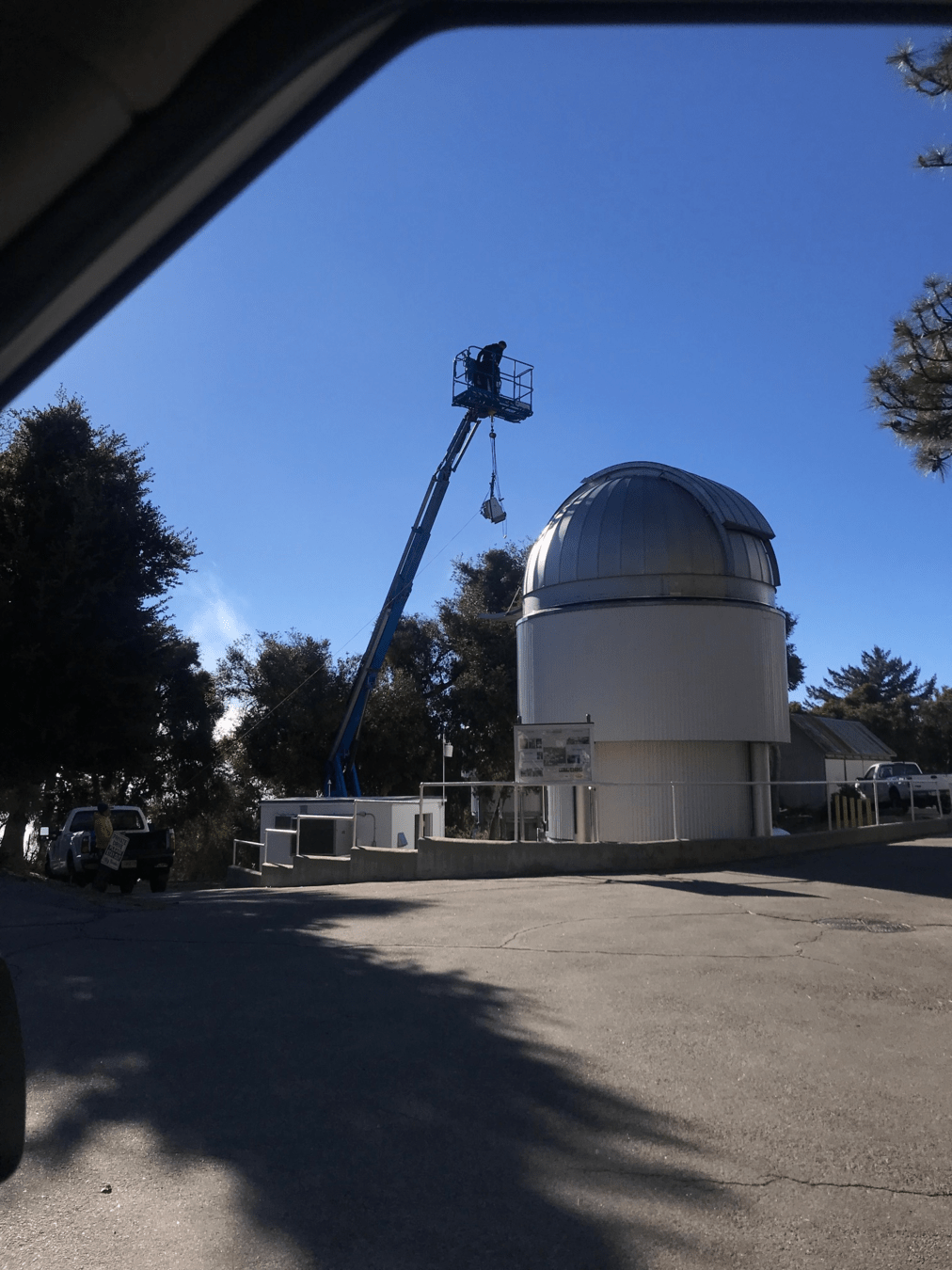

  • Stairs and crypt platform      added for safety
  • W2 done, E2 next
  • S1 weatherstripping and flashing replaced/repaired
    • needed for all scopes

9

Telescopes & Future plans

  • Interface plate done for seeing monitor
  • TelAO instead of TAS for alignment

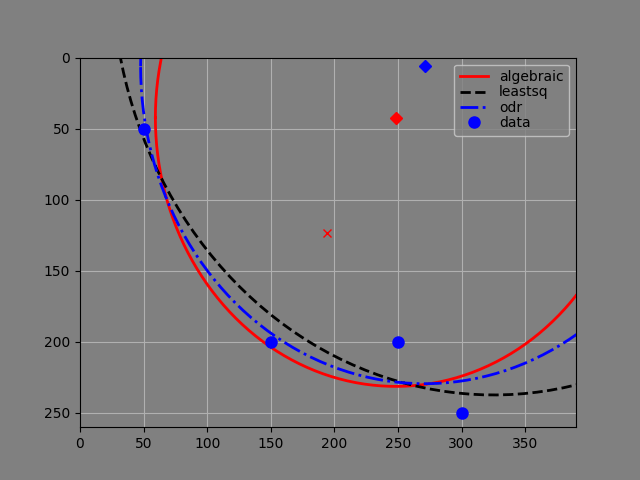

  • circle4.py

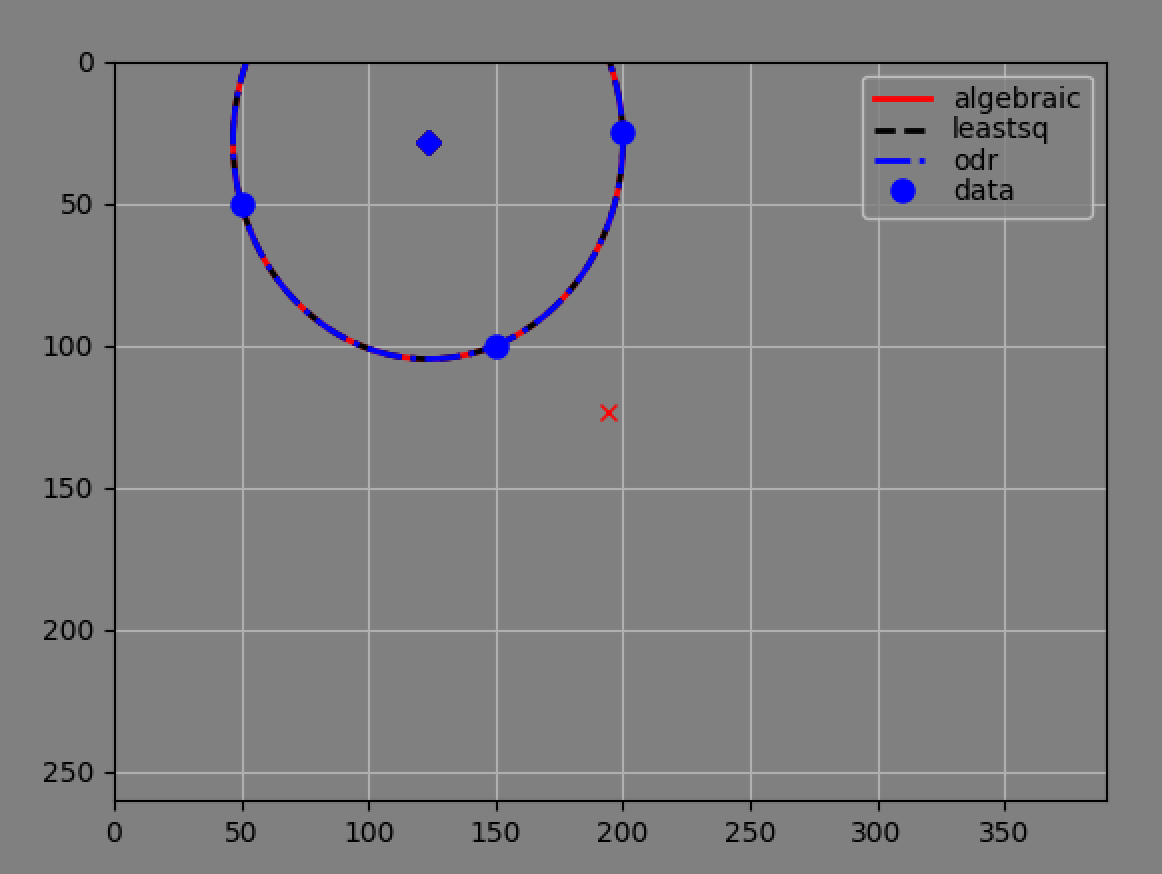

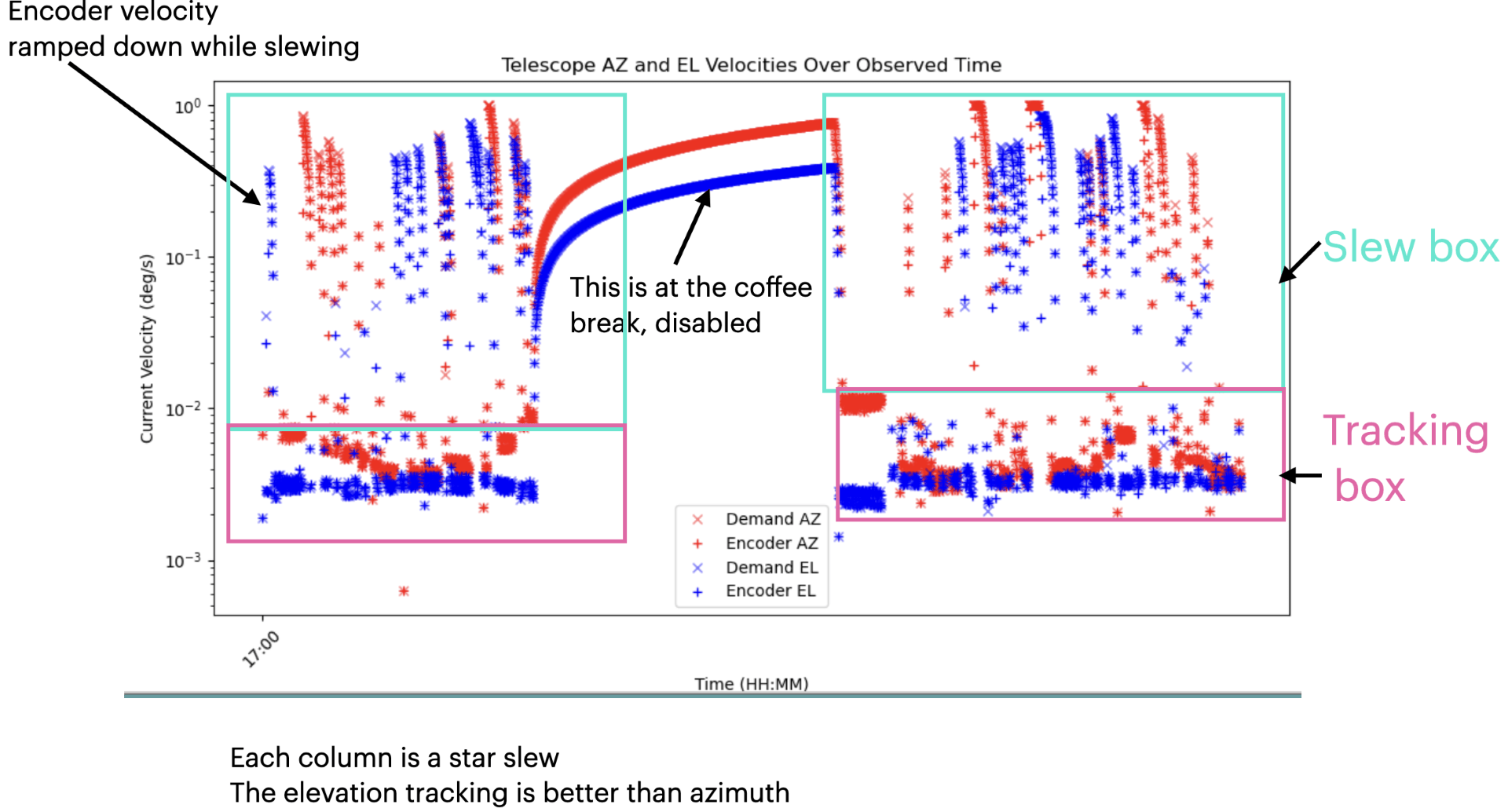

  • speeds and improves EL axis alignment

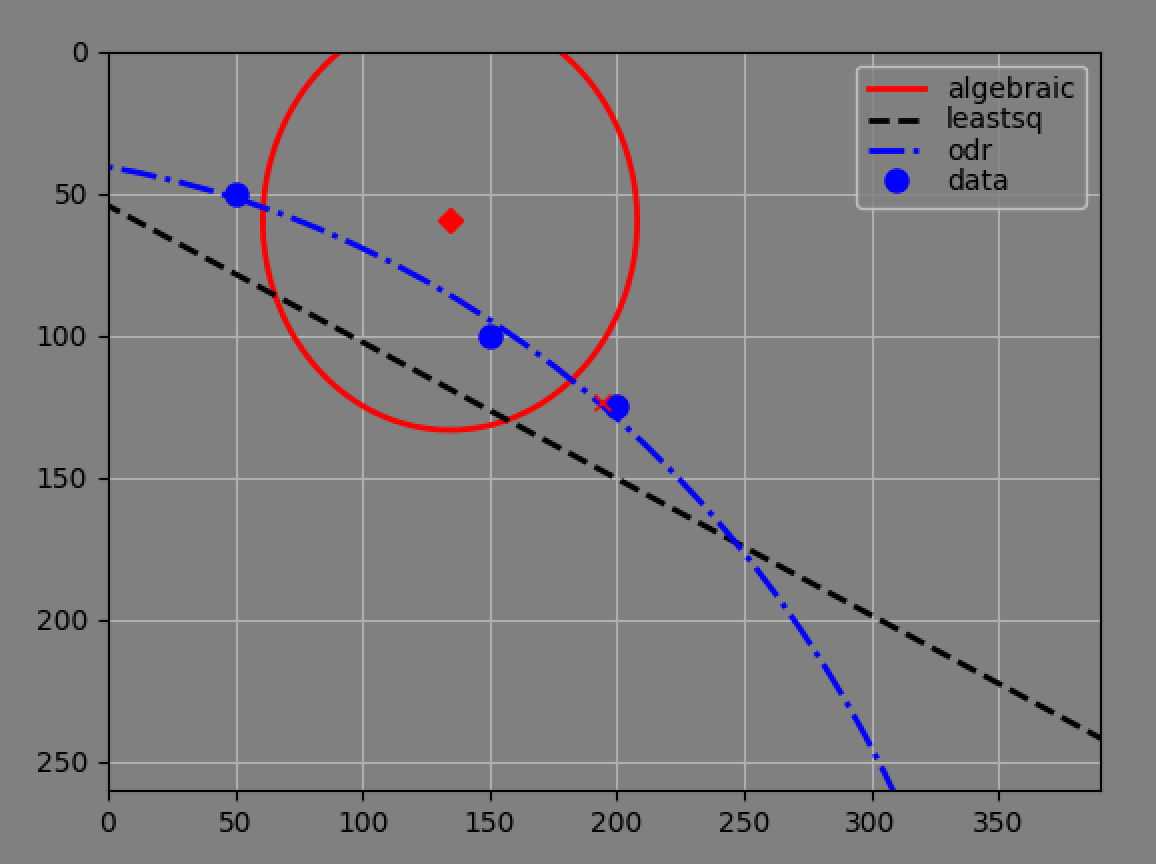

  • predicting circle from 74° of rotation by eye is tricky
  • 3 independent fits for any circle
  • uses pixel values from acq / Brunson aligncam / any camera

10

Telescopes & Future plans

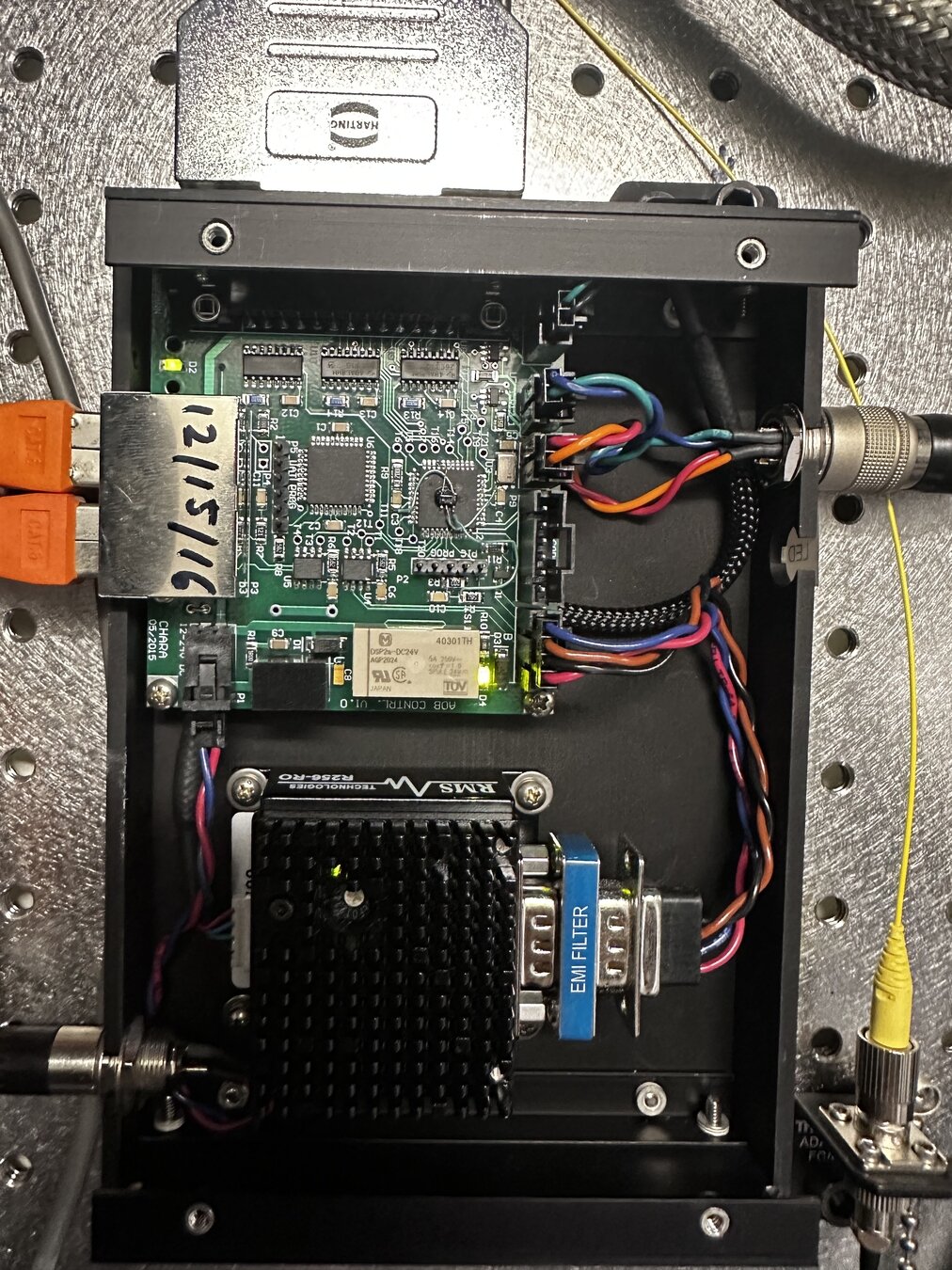

  • W1 issue

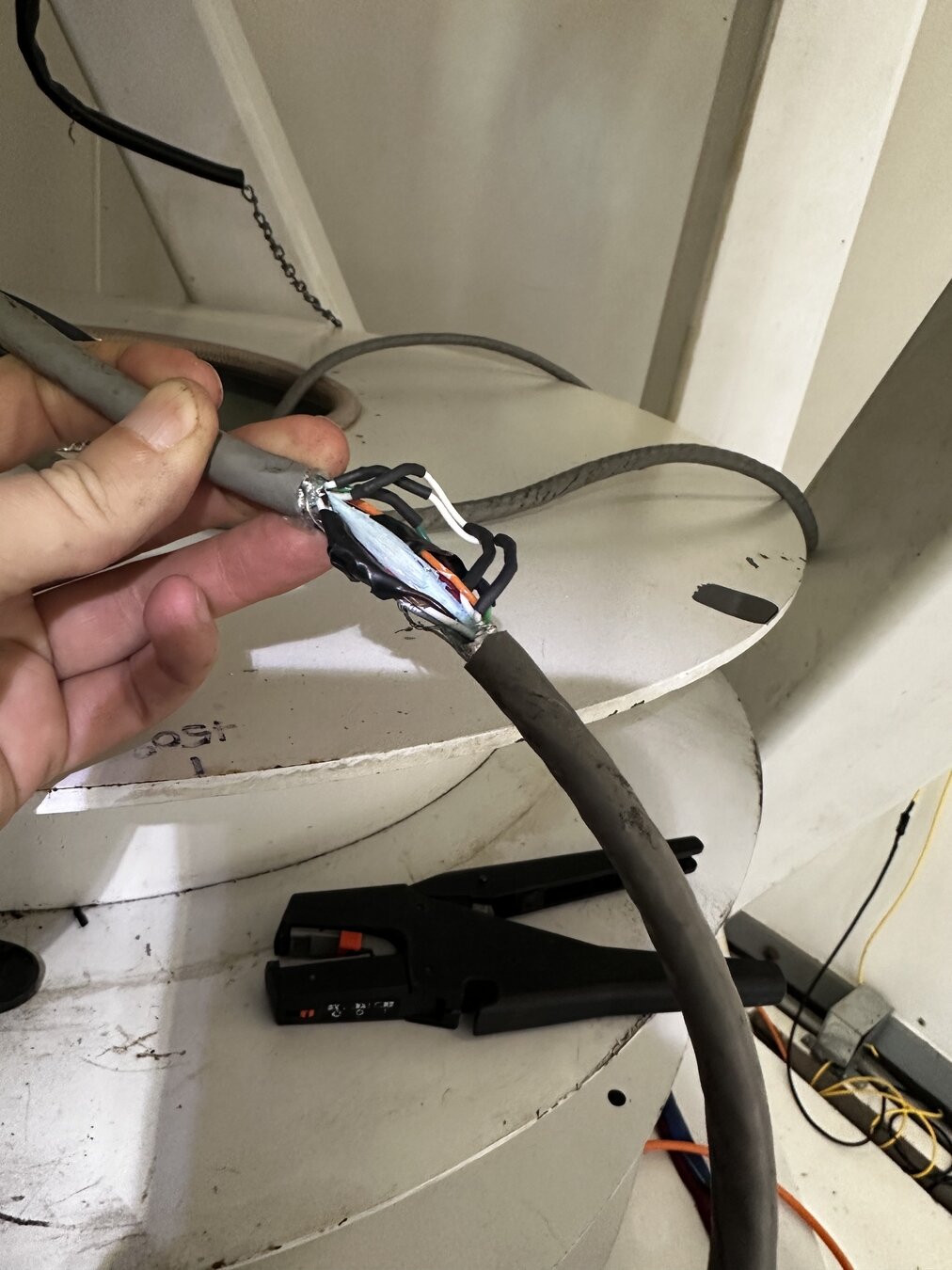

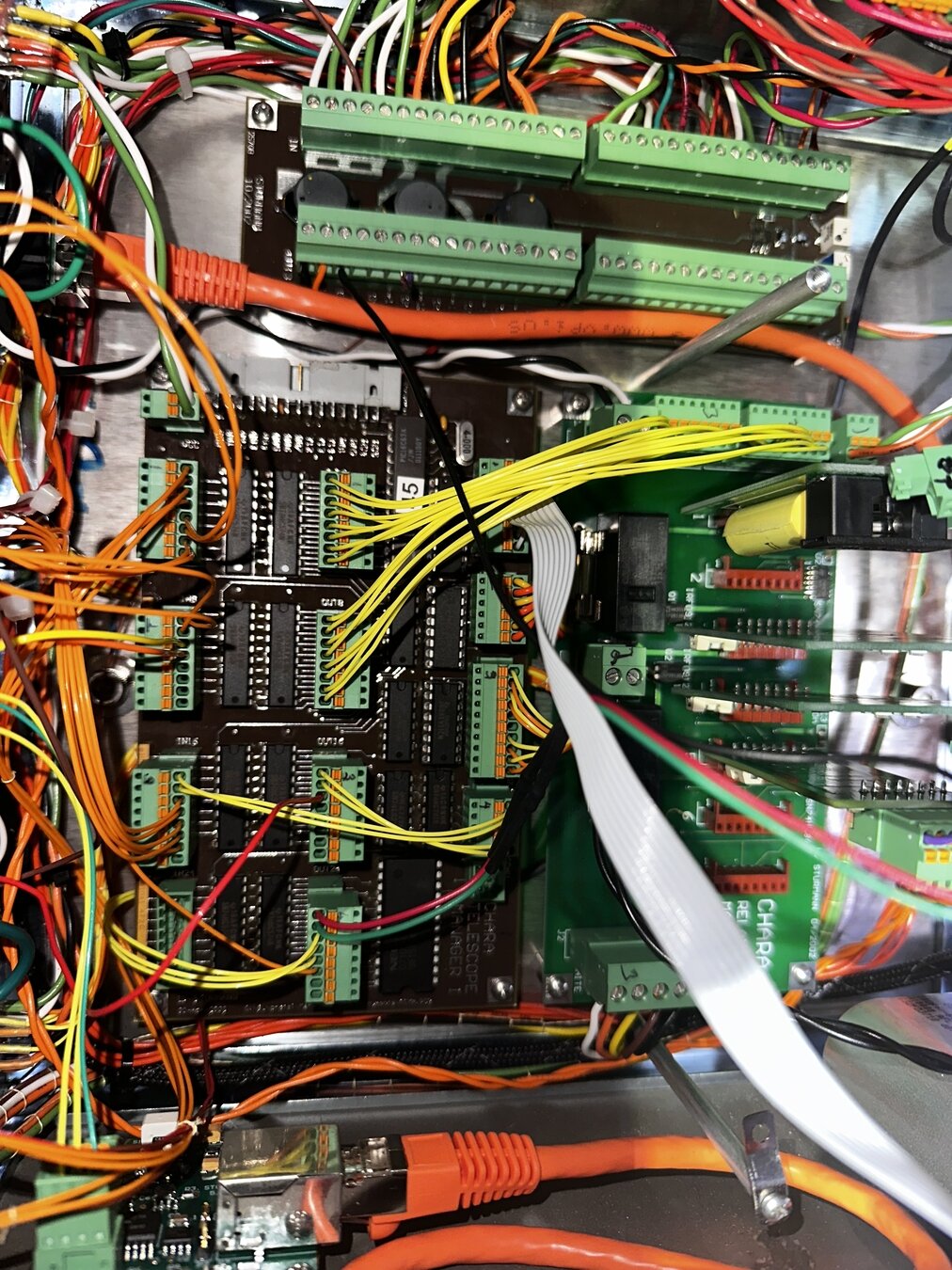

  • Custom pcb's
  • Prone to elec. interference
    • particularly at E2 & W2
  • Very tricky to diagnose
  • Single cable fault may make the whole system not work or work in odd ways
  • Differences b/t scopes
  • Can cascade

11

Telescopes & Future plans

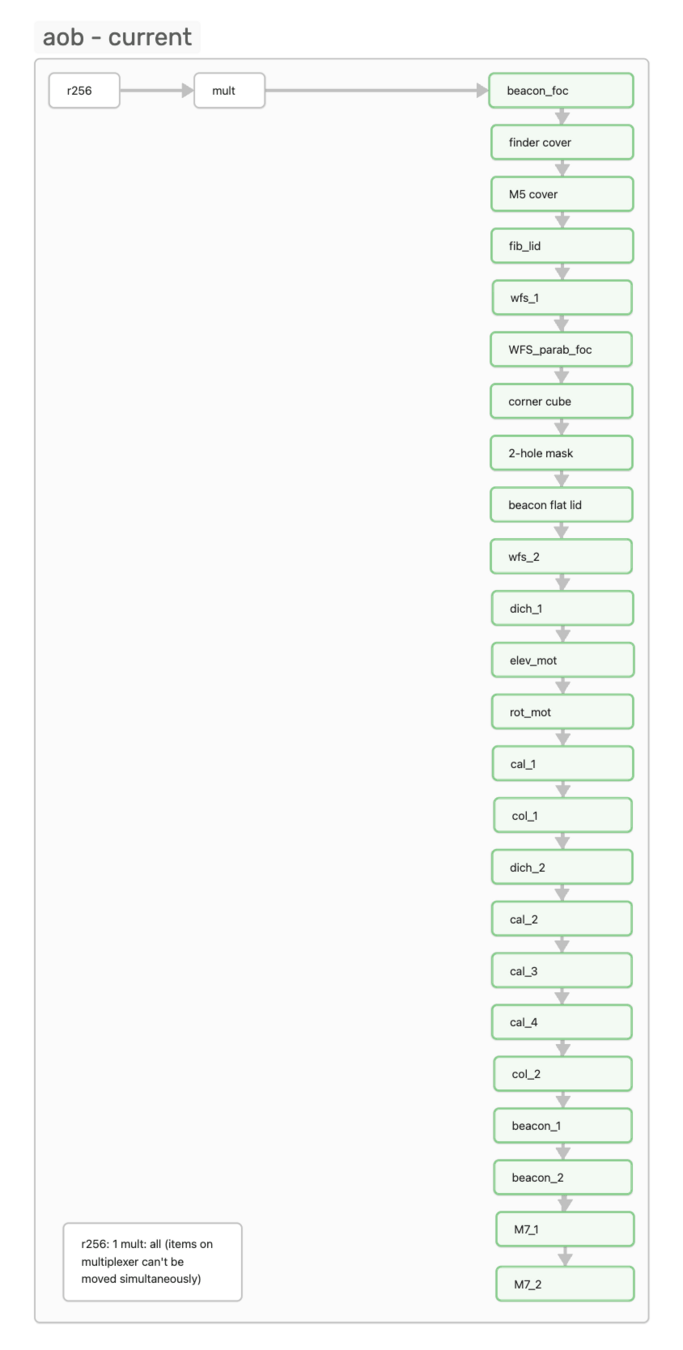

current:

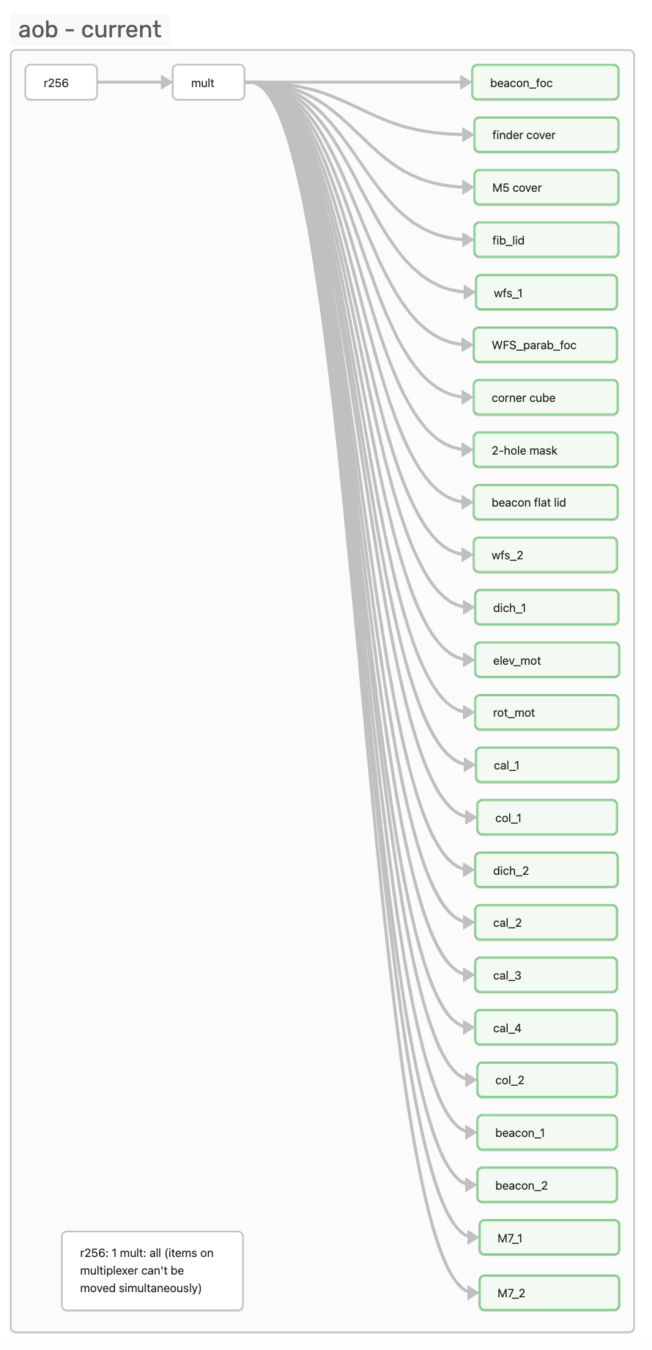

  • single motor driver (r256)
  • multiplexed relays
  • daisy chained
  • sequential operation only
  • little or no feedback, timing-based
  • very difficult to diagnose/repair
  • not necc. interchangable

ideal:

  • 1 r256 per axis
  • no multiplexing
  • parallel operation
  • expensive (>$10k/scope)

12.1

current:

  • single motor driver (r256)
  • multiplexed relays
  • daisy chained
  • sequential operation only
  • little or no feedback, timing-based
  • very difficult to diagnose/repair
  • not necc. interchangable

ideal:

  • 1 r256 per axis
  • no multiplexing
  • parallel operation
  • expensive (~$10k/scope)

12.2

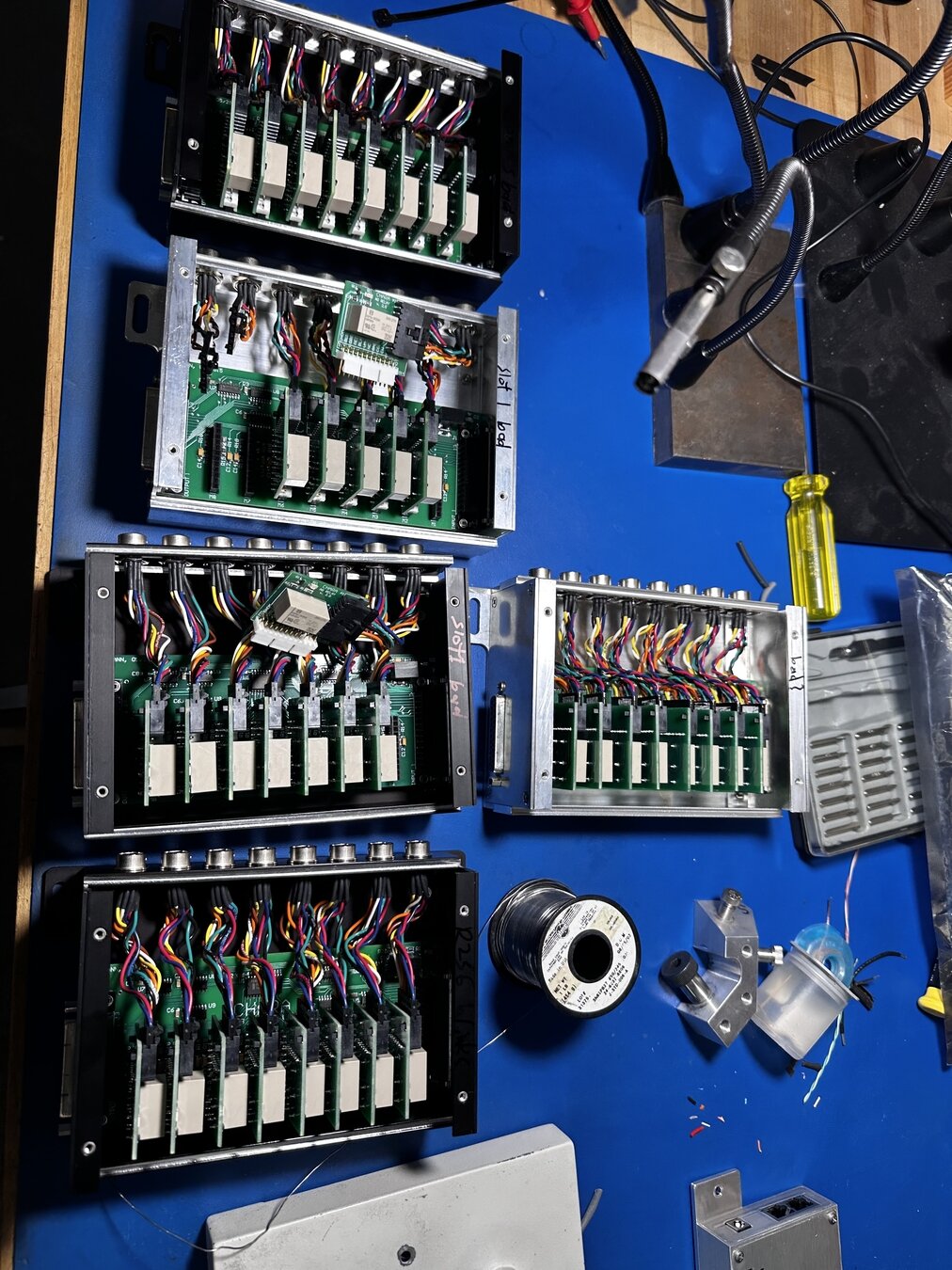

compromise:

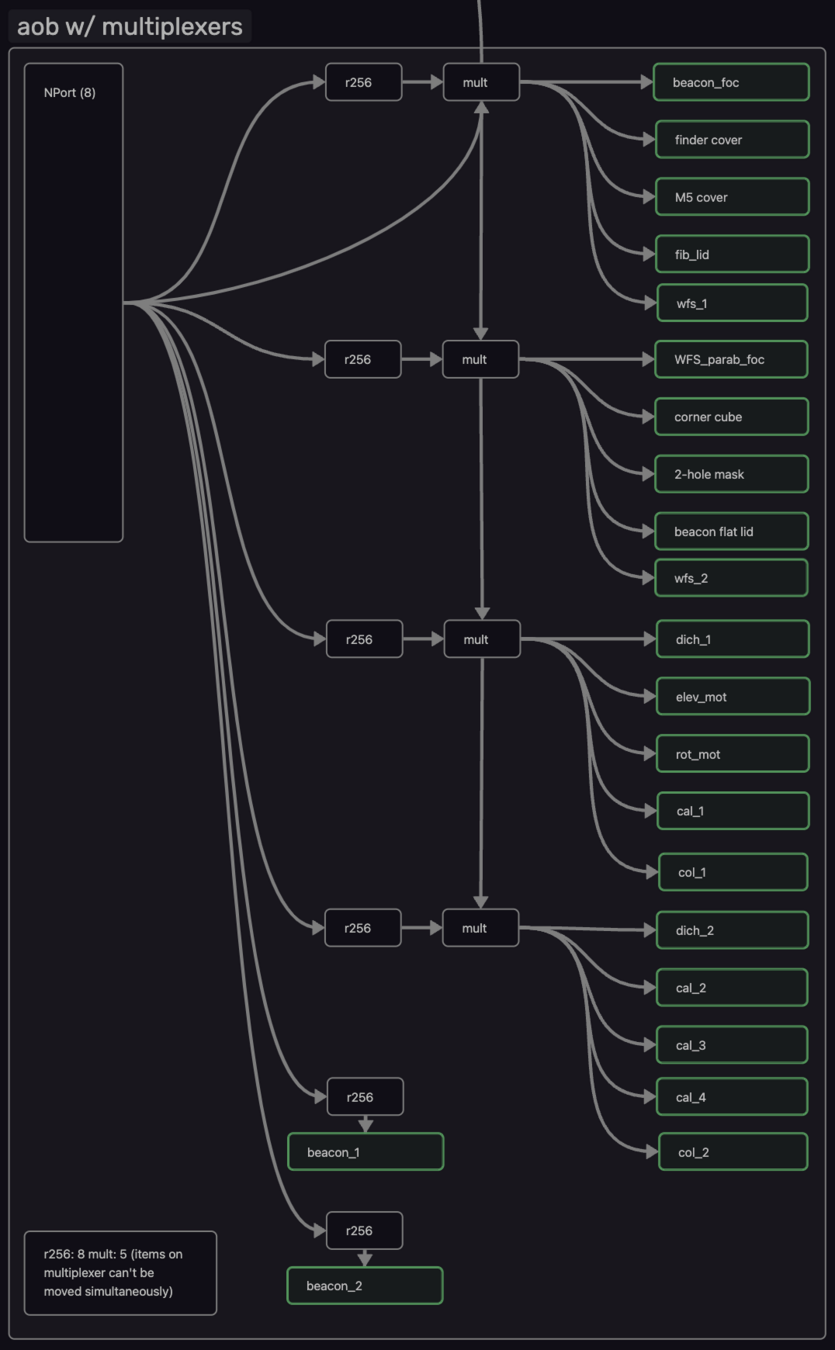

  • hybrid

  • replace aob control and eventually TEMA

  • grouped r256's with 5 multiplexors
  • only multi. those that don't need parallel operation (covers & lids)
  • need to design multiplexor
  • relatively easier to isolate and replace components
  • expensive (~$5k/scope)

13.1

Telescopes & Future plans

compromise:

  • hybrid
  • replace aob control and eventually TEMA

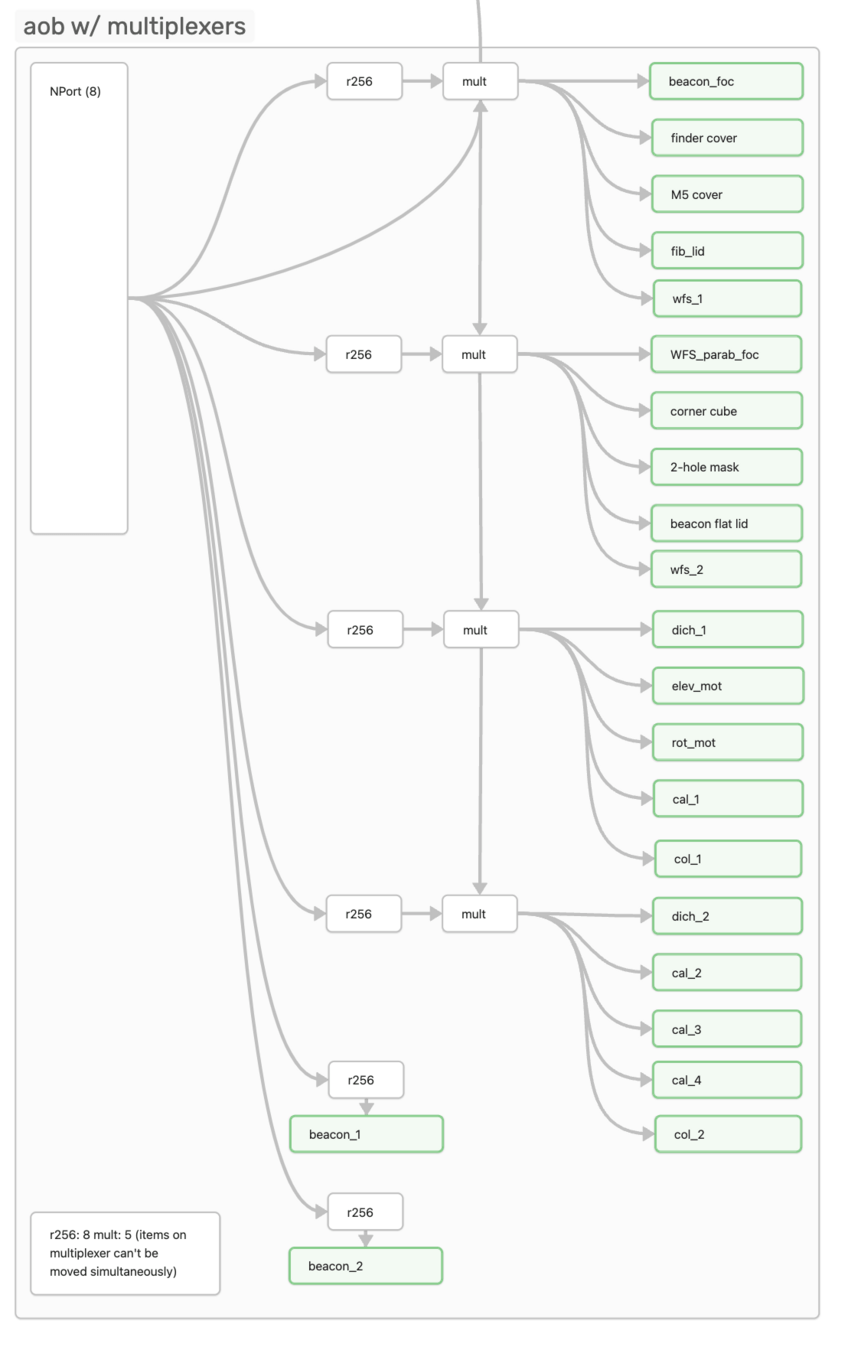

  • grouped r256's with 5 multiplexors
  • only multi. those that don't need parallel operation (covers & lids)
  • need to design multiplexor
  • relatively easier to isolate and replace components
  • expensive (~$5k/scope)

13.2

Telescopes & Future plans

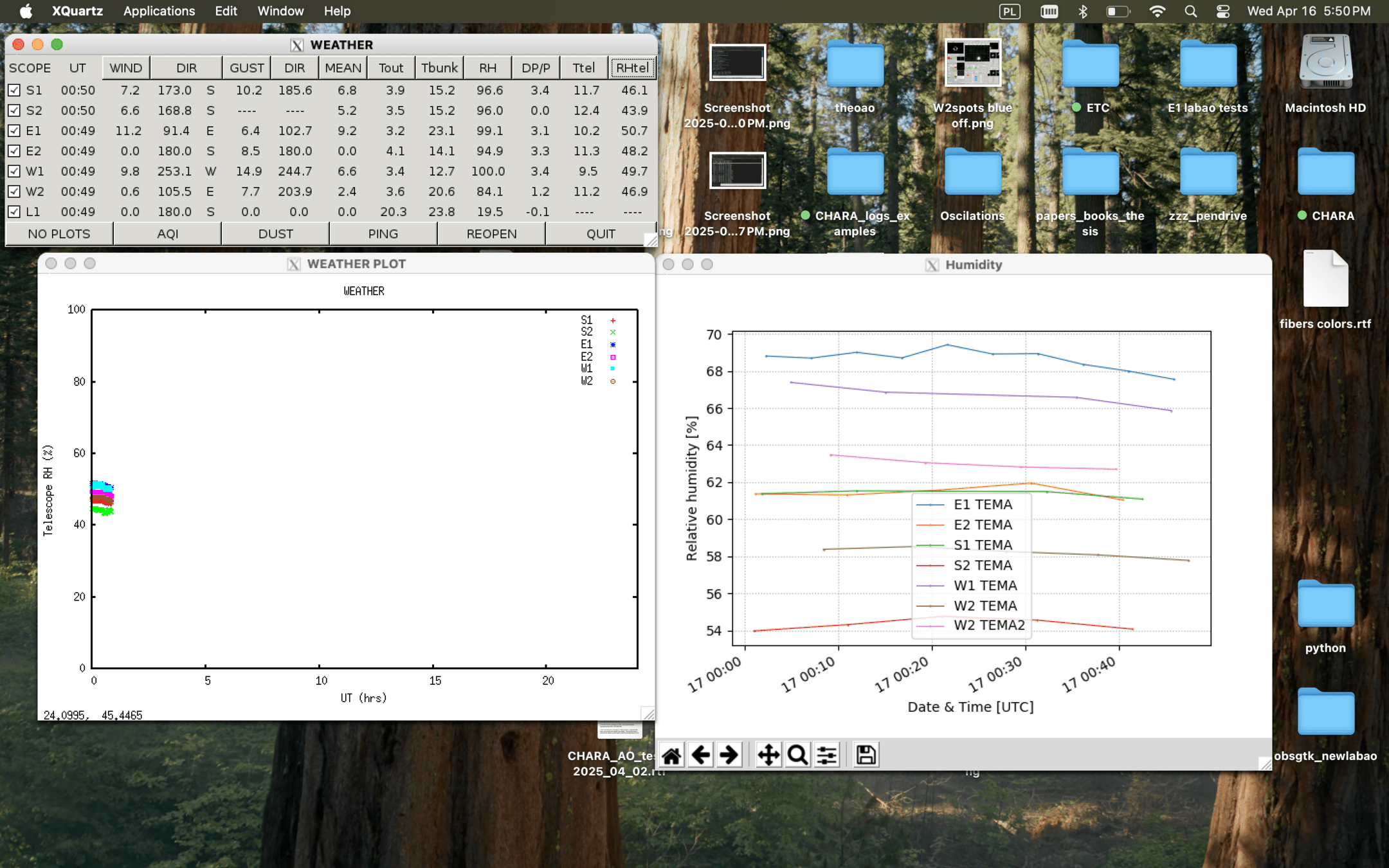

  • AOB/TEMA/HUT
    • RPC to control dehumidifiers and heaters based on minions (2/3 voting scheme)
  • Cable wrap concerns
    • sharp edges
    • friction welding
    • routes
    • reduced cables in wrap
  • Heidenhain encoders/tape
    • some show wear/damage

Impact of SPICA and moving actuators:

  • 17 cases of beacon flat/m7 motors stuck / runout
  • All required working on the motors and realigning
  • All during SPICA runs or eng.
  • Each was few hours of work.

14

Telescopes & Future plans

TEMA

15

Telescopes & Future plans

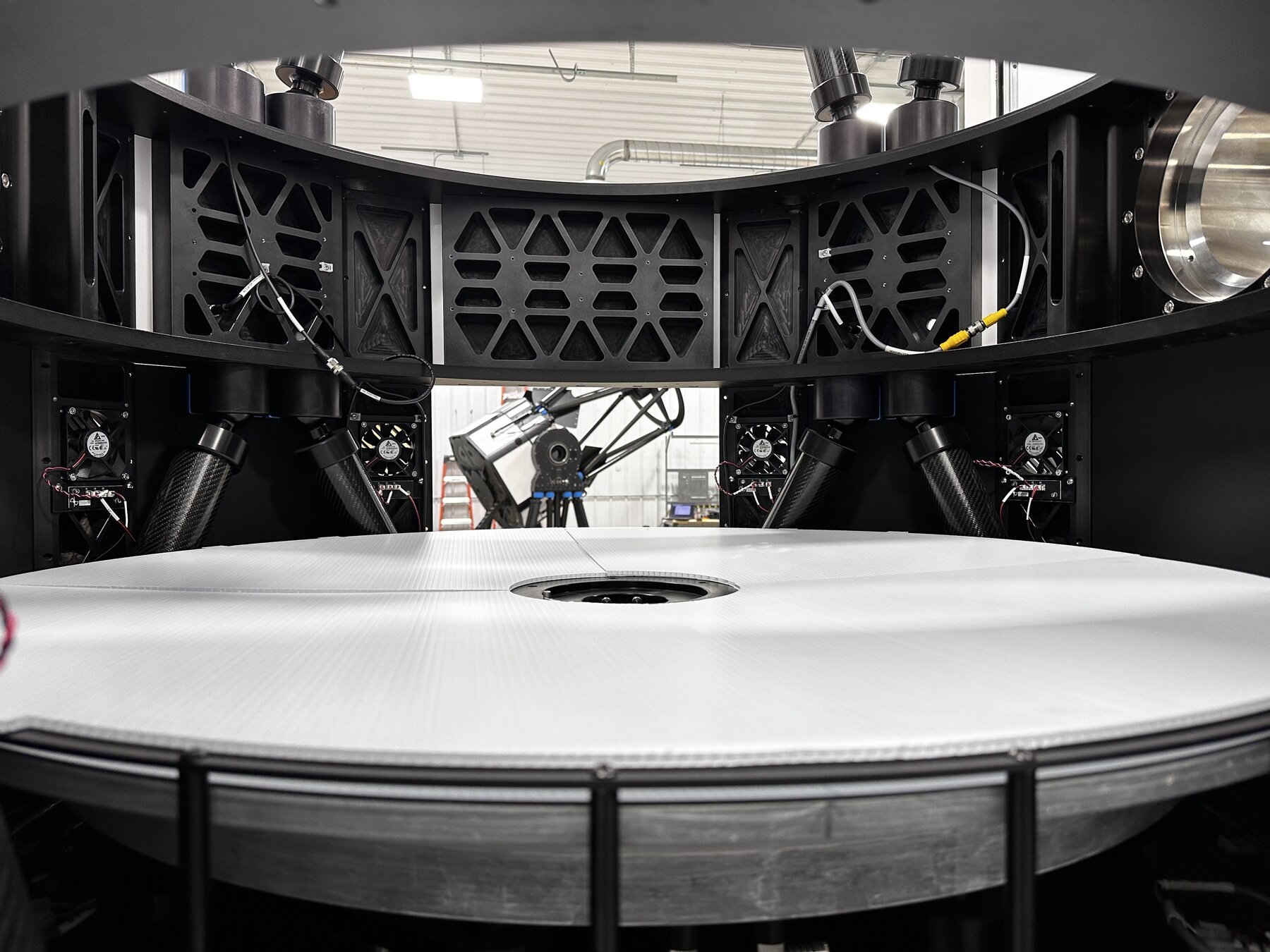

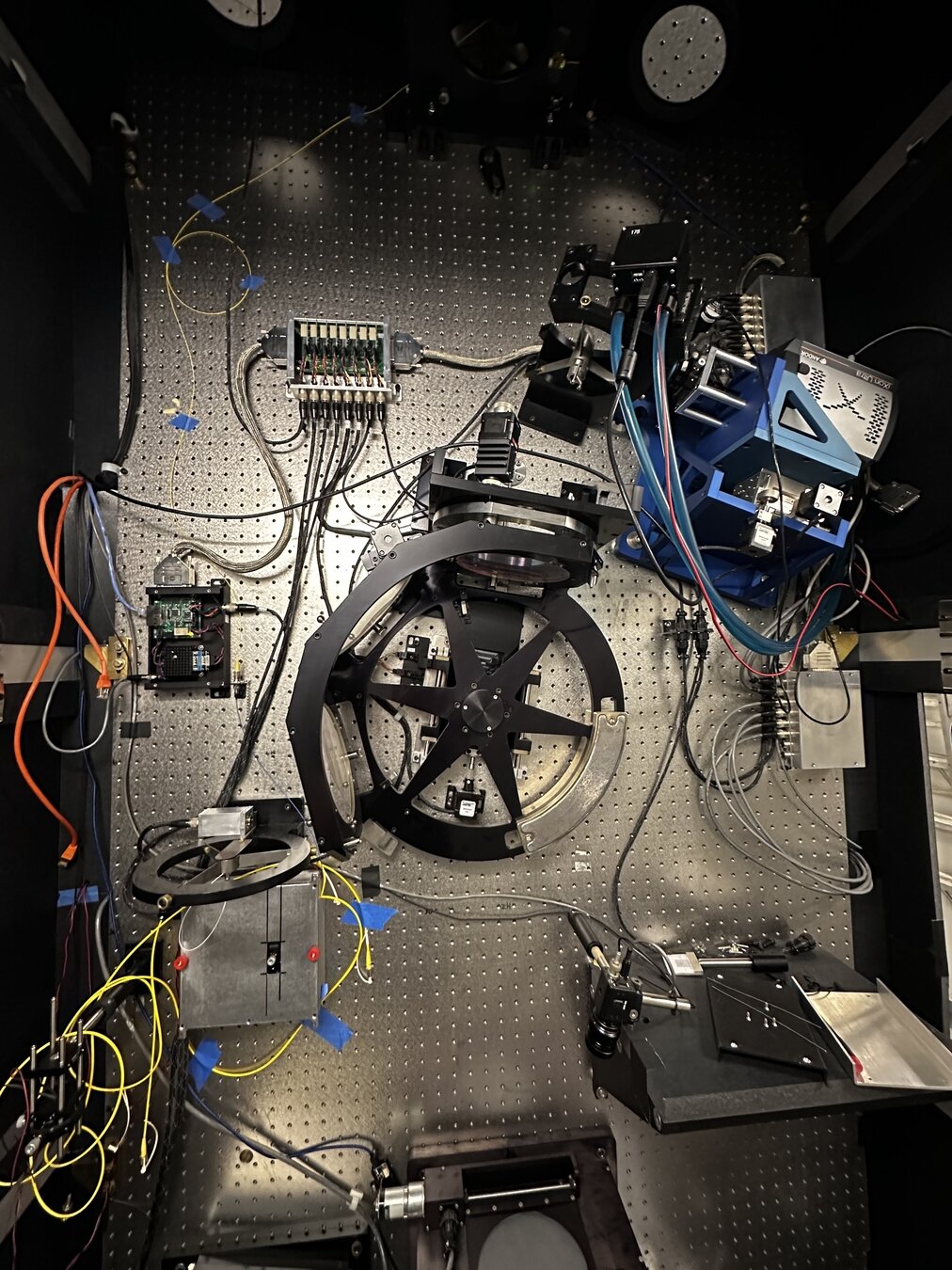

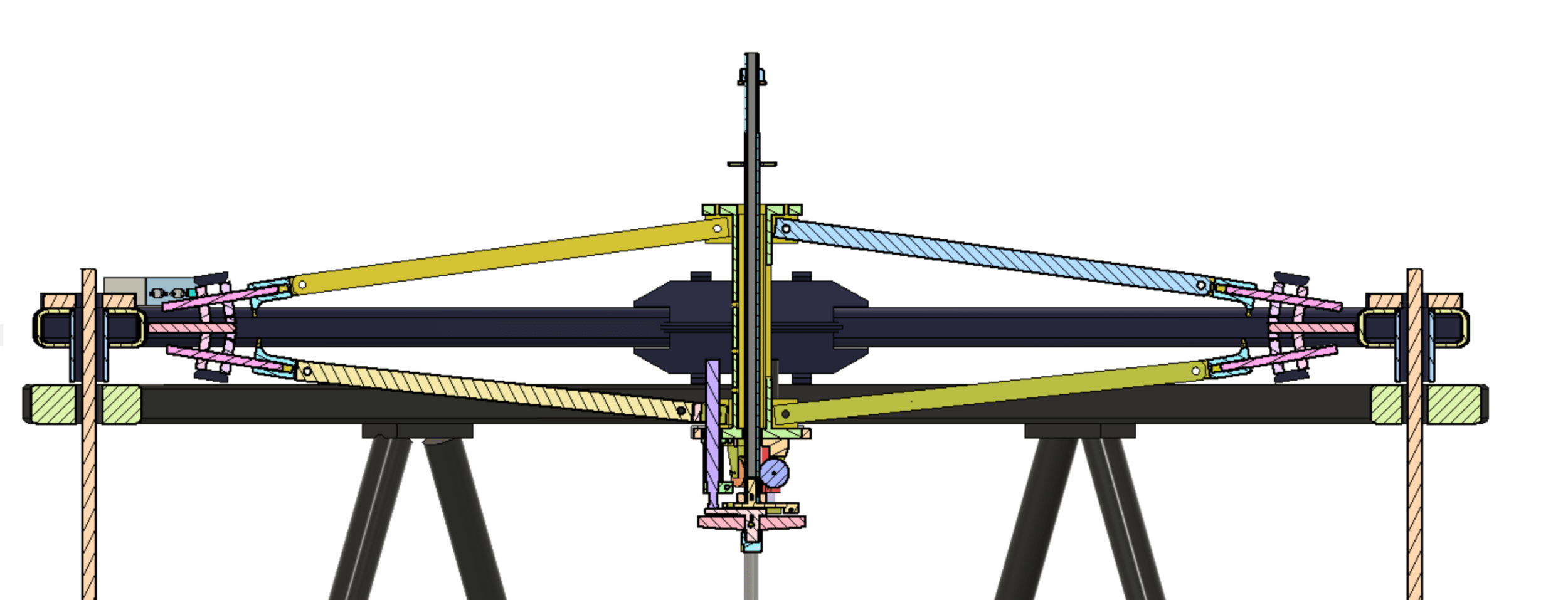

cylinder upgrade

16

Telescopes & Future plans

  • done at S2 & W1
  • rest are ready
  • fan control added
  • same for aob

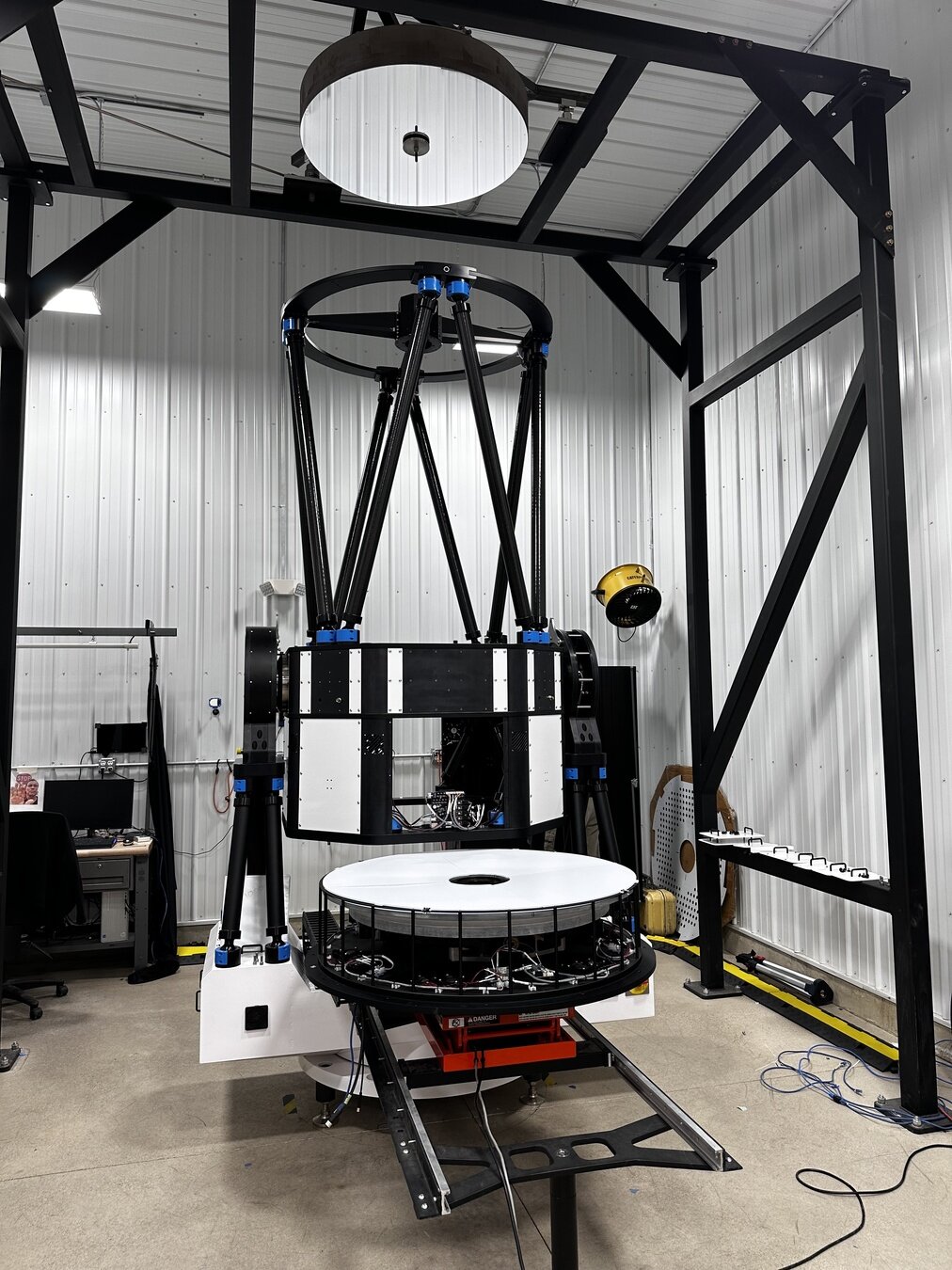

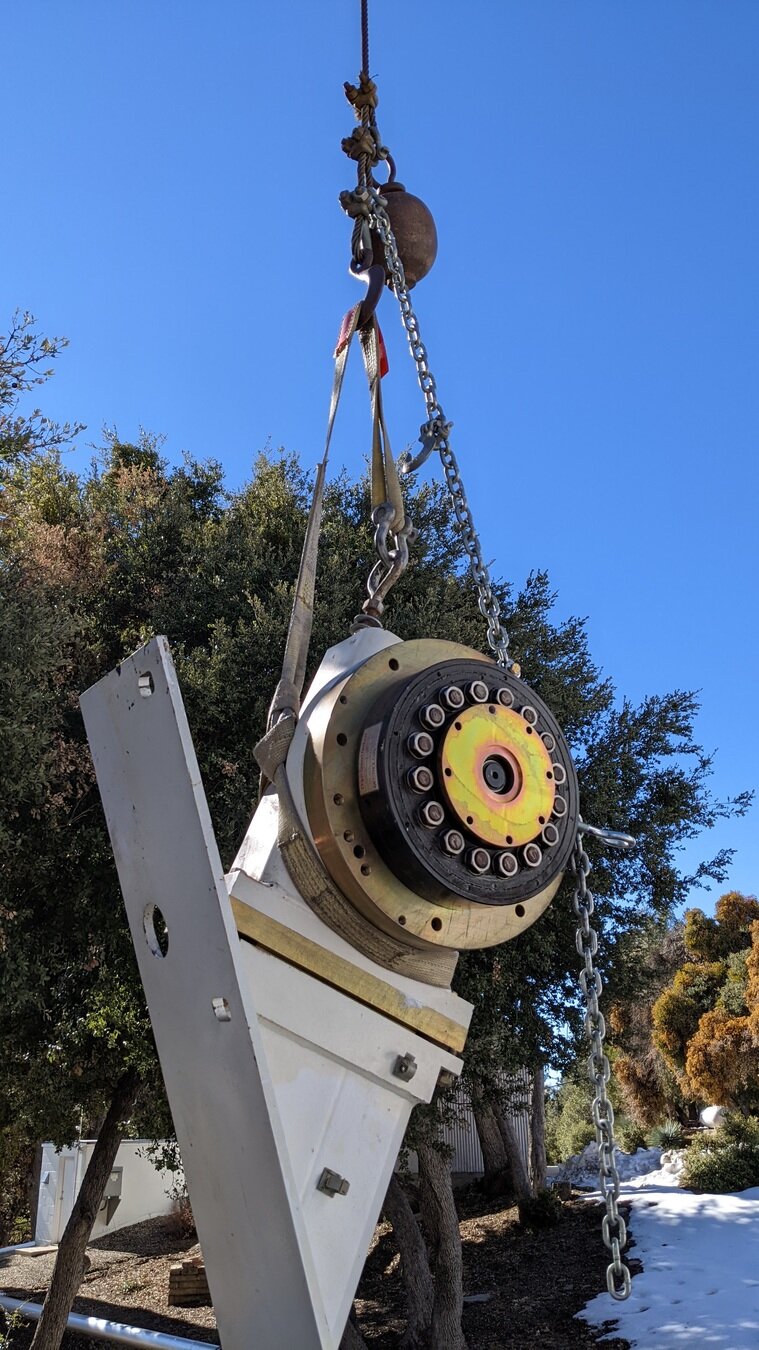

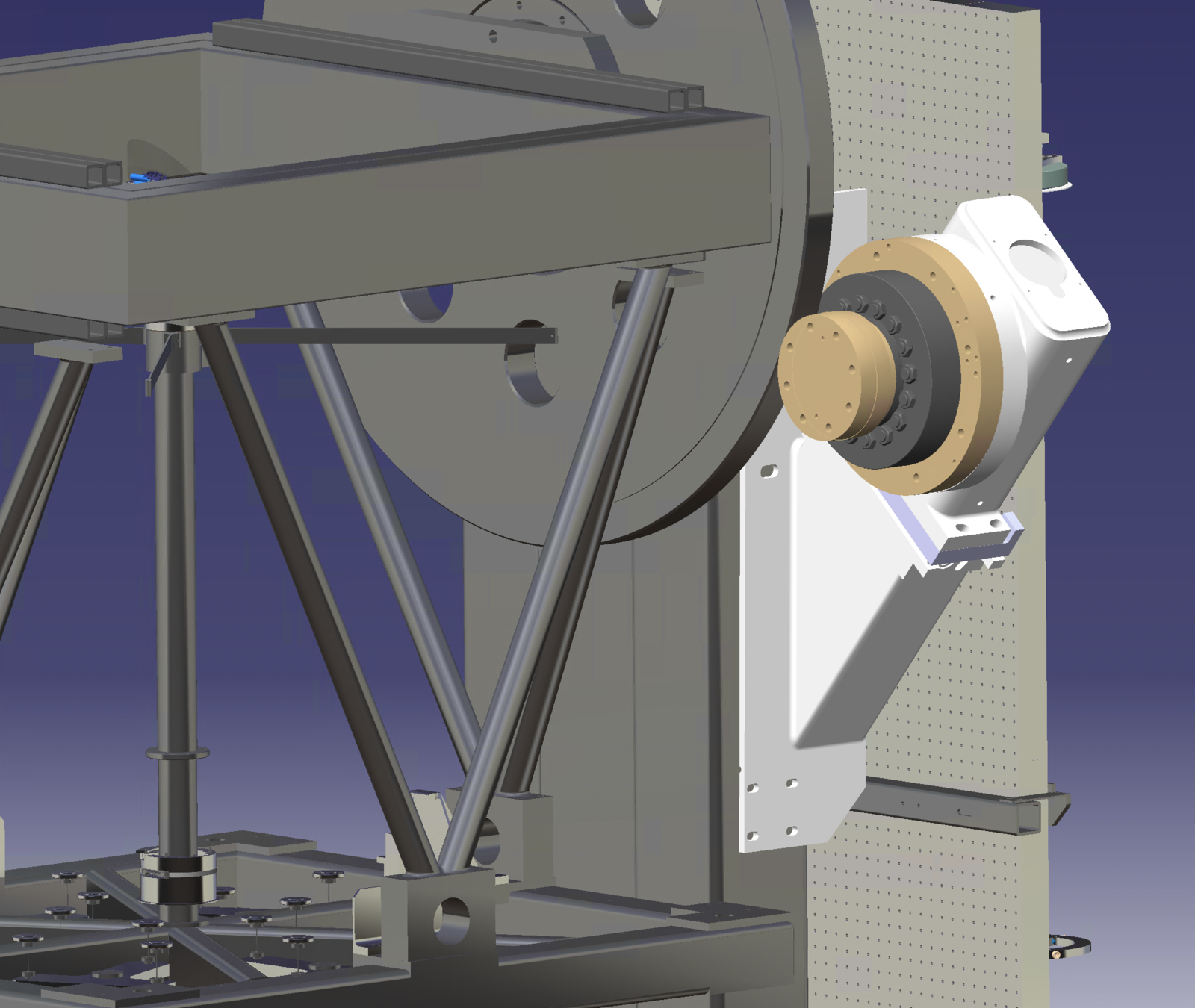

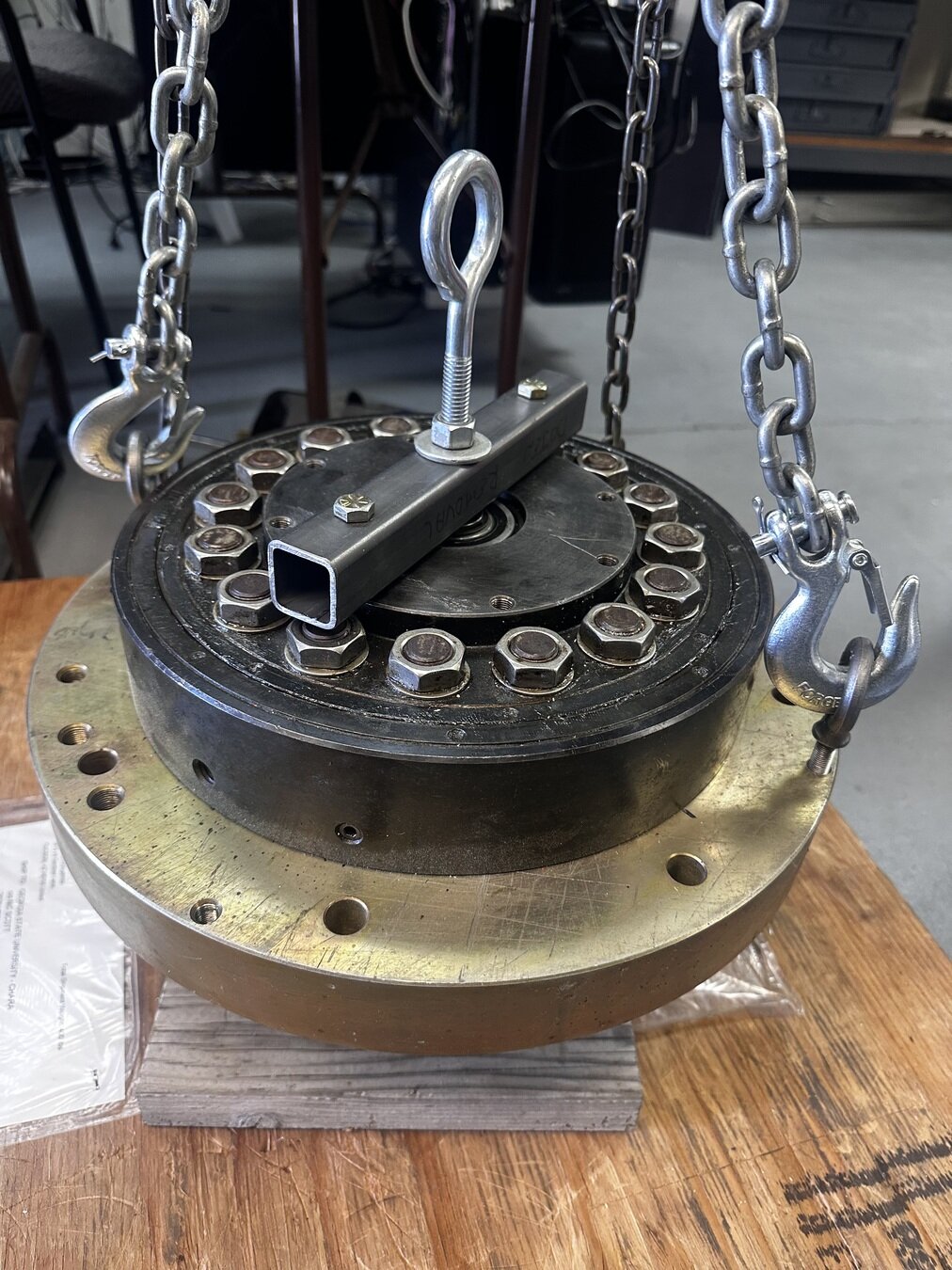

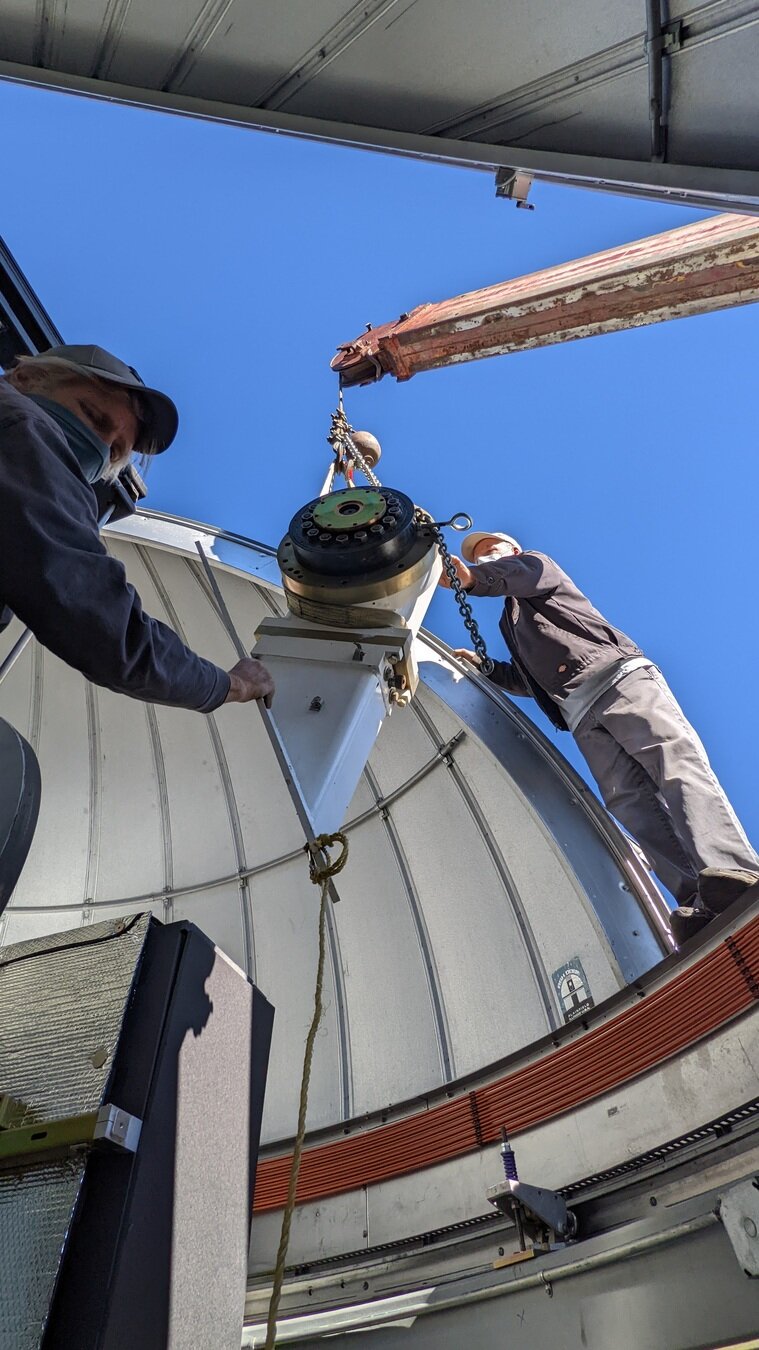

Drive Upgrade

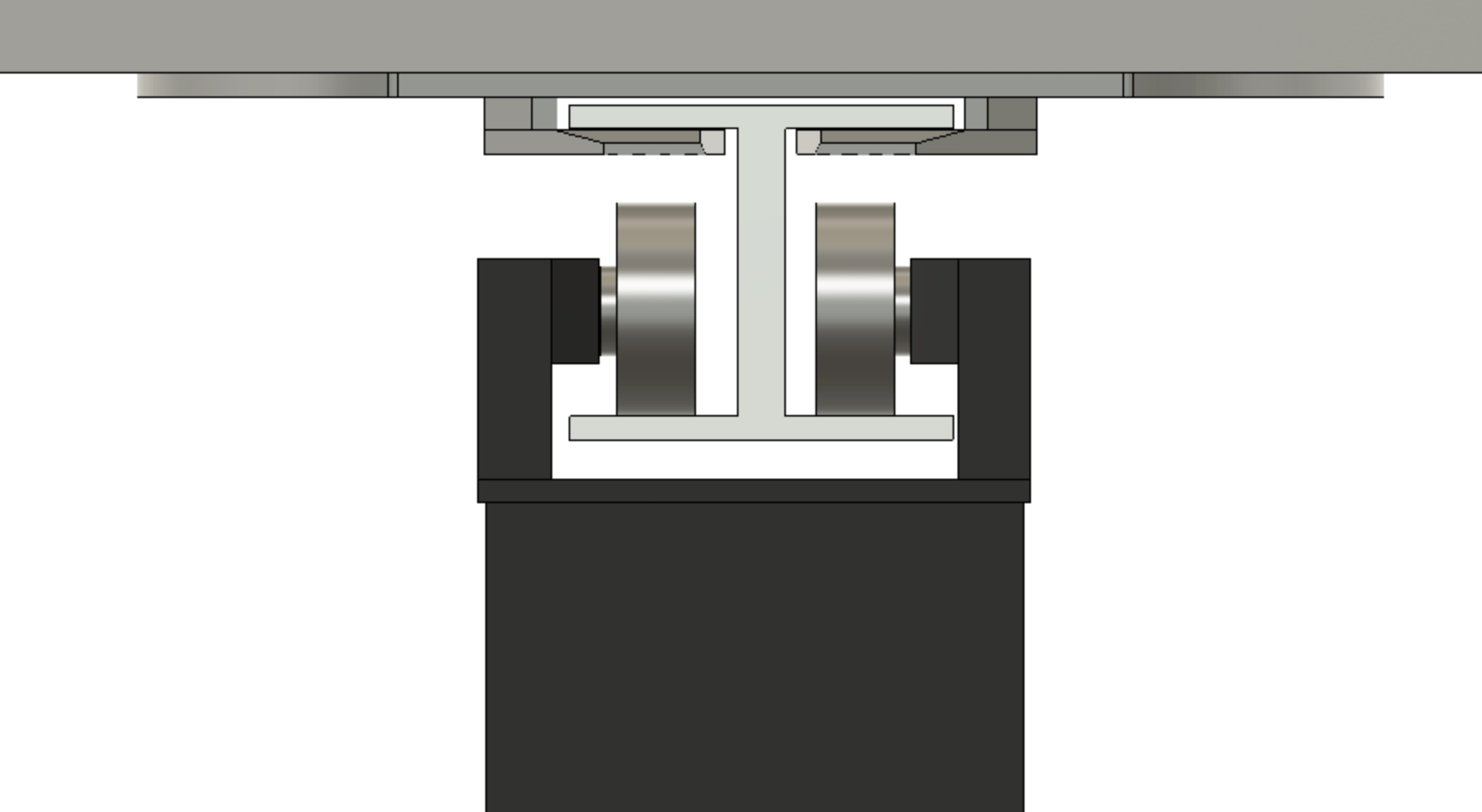

  • S2 done and has been in use for a season, W1 after meeting

  • Existing drives are ~25 years old & discontinued

  • Reduce vibration, improve tuning

  • Prototype assembly and short pivot arm done

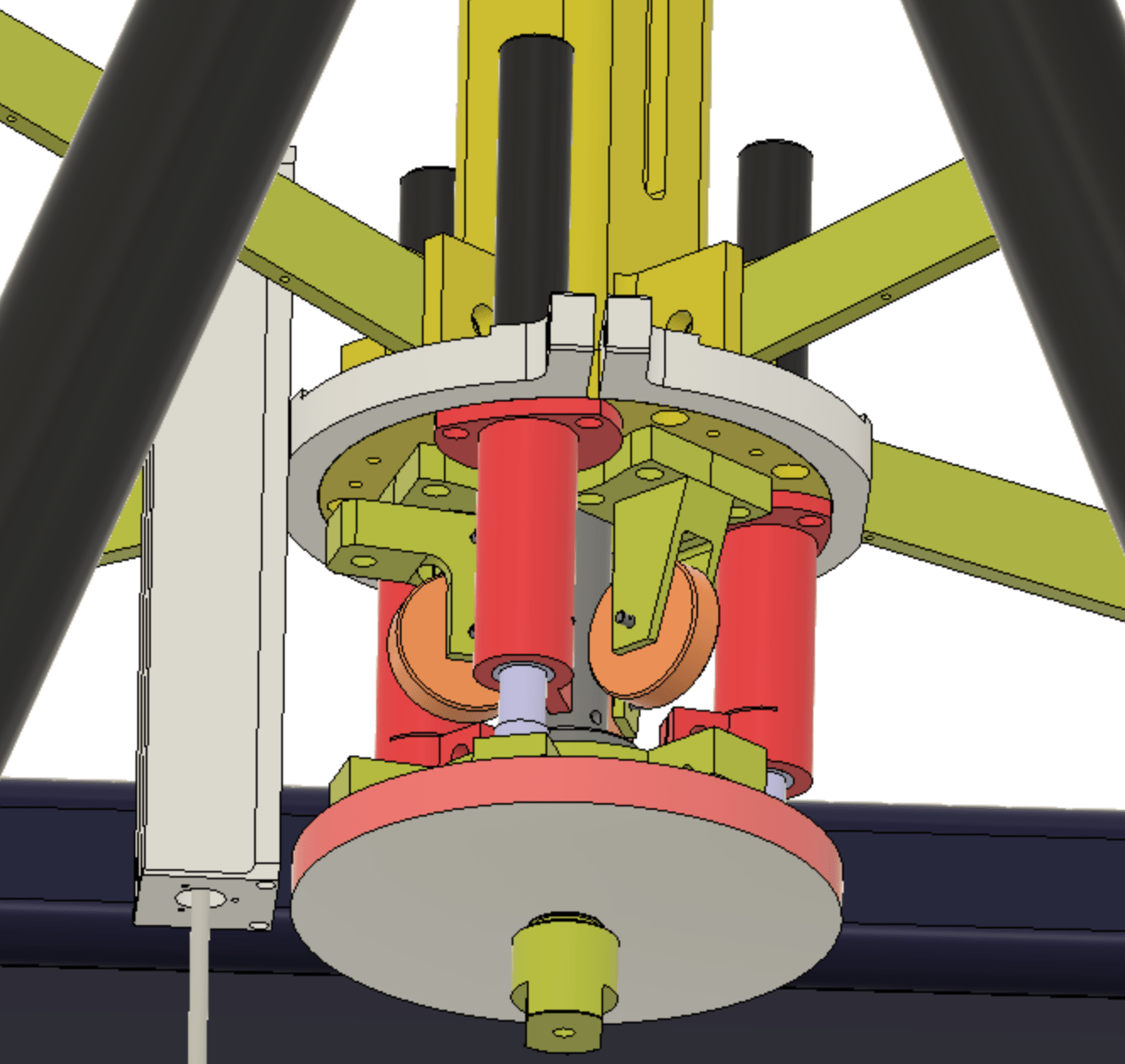

  • 12 drives and motors (plus spare) in hand from Parker

  • Drive assemblies fabrication done (2 done, 10 remaining) - ahead of tariffs
  • Spare Dojen obtained
  • Install during daytime, but some nights needed for software and tuning

17

Telescopes & Future plans

18

Telescopes & Future plans

Tiptilt, PZT issues, actuators, hexapods?

  • 11cm: spider → back of M2
  • adjusting spider could get few more cm

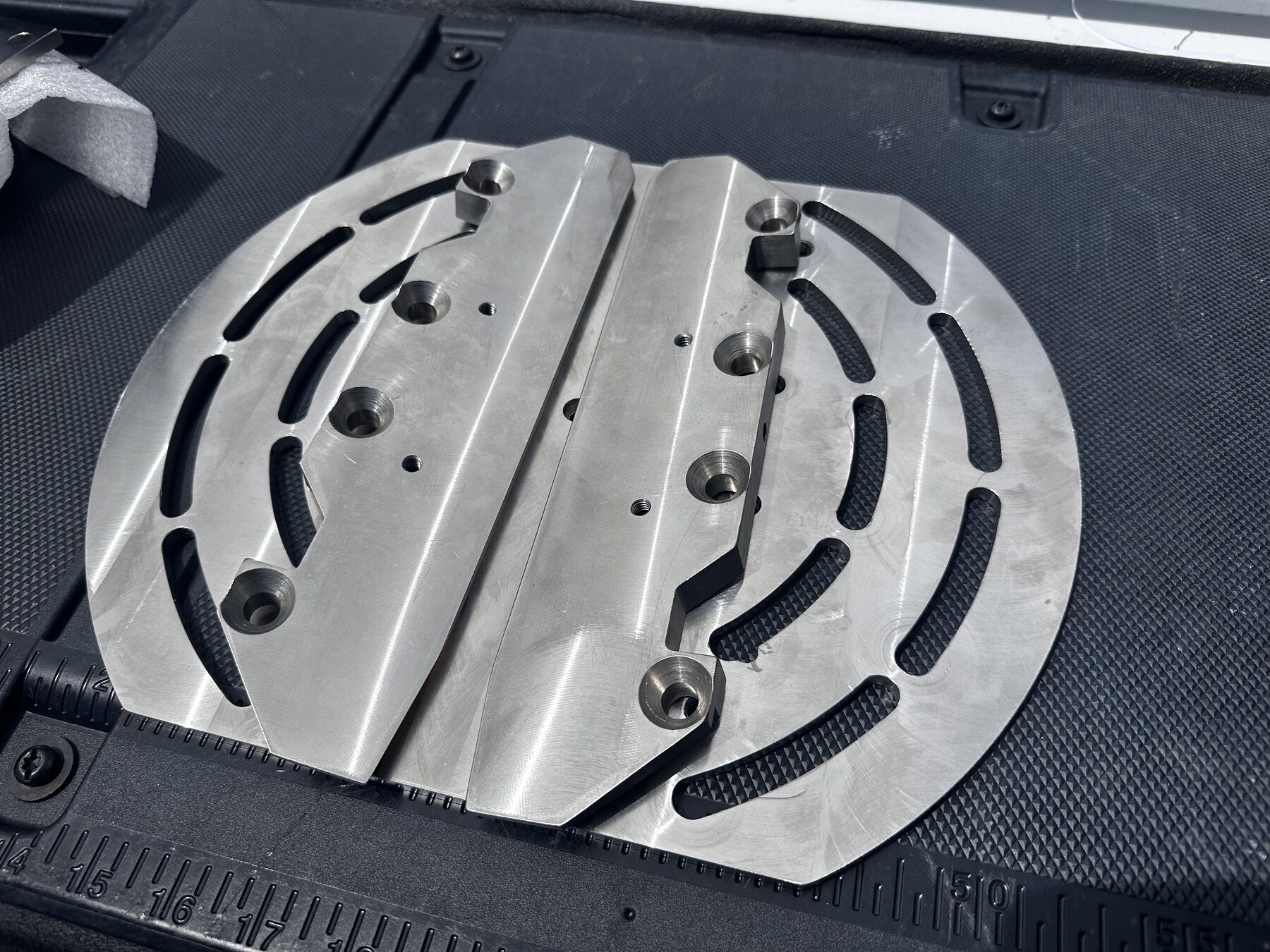

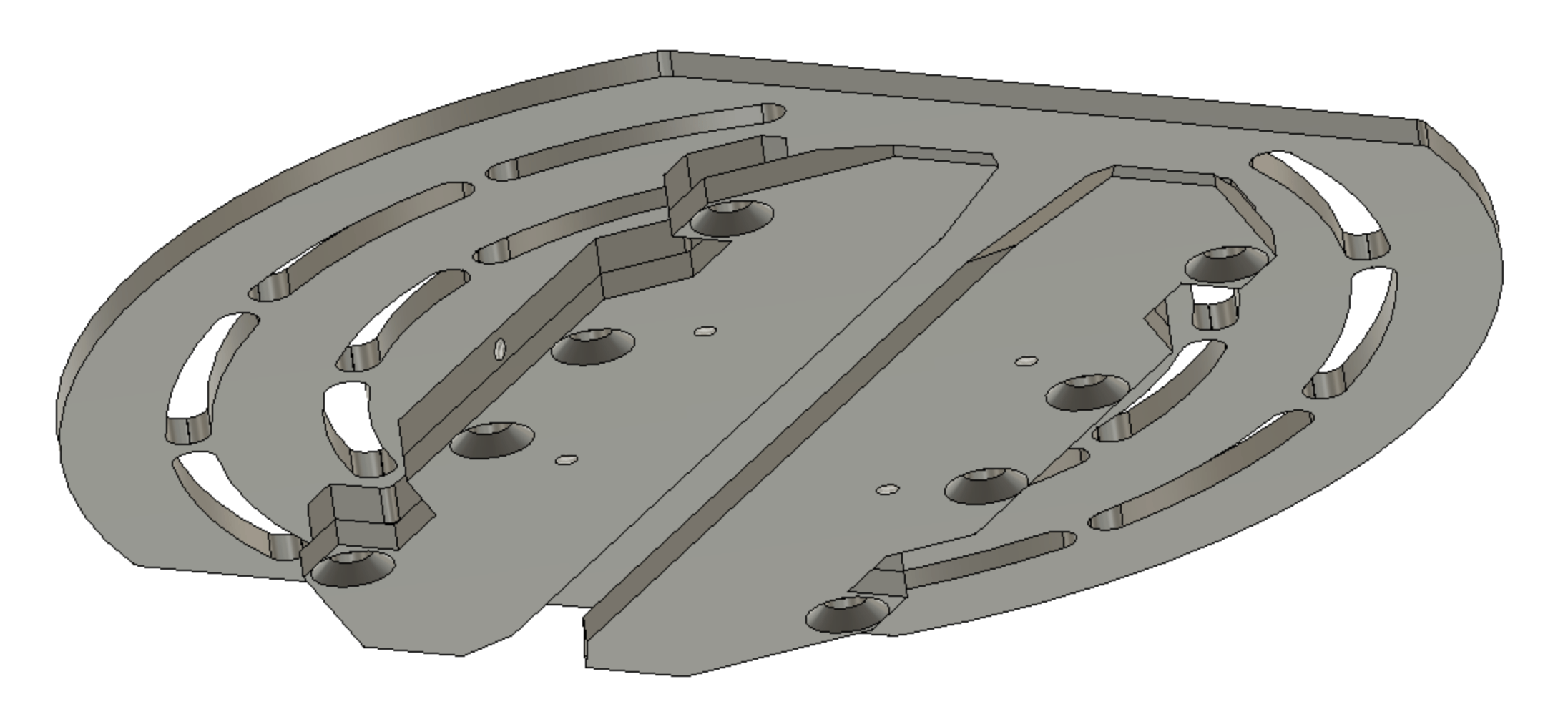

  • M2, d=140mm
  • may need a piezo tiptilt system b/t hexapod and M2, but depends
  • needs to function hanging upside down
  • Tiptilt concerns
    • PI PZT's discontinued in 2018, could be sent for repair but limited
    • use DM for TT correction (but can't do on-sky reconstructor in this case)
    • actuators were discontinued in 1992
    • replace PI PZT's with Thorlabs PZT's or newer PI actuators+PZT
    • get one hexapod (~$50k) and then we have spare parts for rest of array

19

Telescopes & Future plans

New fiber network (new IP pool)

new spycam system (3 per telescope up to 4k+audio, 3 w/ pan/tilt in lab), more sensors (rh, temp) and control

20

Telescopes & Future plans

Plan Outline:

  • Phase 0: AC at telescopes
  • Phase 0.1: new IR dichroics for beam samplers
    • Improve multi-wavelength performance
    • Wider bandwidth for better STST performance
      • CRED1, bluer for science, WFS on a single chip?
    • Dual-star phase reference mode
  • Phase 0.5: upgrades of telAO
    • Redesign M2, go to focal design?
  • Phase 1: central 2m + AO + OPLE upgrades
    • LabWFS control new telDM,
    • Longer delay + better metrology or double-decker carts
      • Visible-sensitivity, resolution, stability →  needed for nulling
  • Phase 2: replace 1m's with 2m's
    • Propagate upgrades from central 2m
  • Phase 3: full CMA - outer km baseline fiber array

(2024 Meeting on CHARA Future)

21

Telescopes & Future plans

Central 2m Telescope

  • Vacuum beam transport with fiber option
  • Bundled with Delay Line Upgrades

22

Telescopes & Future plans

  • Review the current state of capabilities & techniques in optical/IR interferometry
  • Discuss quantum-enhanced methods for pushing current limitations on spatial resolution
  • Establish collaborations between the astronomy & quantum communities to address science requirements and technical challenges

"Performance of the Khabiboulline Configuration of Quantum Enhanced Long Baseline Optical Interferometry"- Mcclinton & Ridgeway (AAS 2025)

"Towards quantum-enhanced long-baseline optical/near-IR interferometry"

Rajagopal et al. (2024)

open-air or quantum-enhanced future beam transport?

23

Telescopes & Future plans

Initial HBT experiments planned this yr with BNL

"Towards Quantum Telescopes: Demonstration of a Two-Photon Interferometer for Quantum-Assisted Astronomy" - Crawford et al. (2023)

Risks:

very uncertain US environment

Funding options:

- NSF (66% cut proposed)

- private: Heising-Simons Foundation, Keck, Kavli Instititute, others

- extend the consortium?

- other universities?

- National lab status?

- International partnerships?

25

Telescopes & Future plans

26

  • Central 2m telescope
  • 1m's → 2m's
  • Km+ baselines
  • AO/ople/lab upgrades
  • Off-target phase tracking
  • Nuller
  • Future beam transport
  • Michelson Array

(bigger future plans)

CHARA in 2040

  • Telescope dichroic upgrade
  • Automated alignment/tracking
  • Upgrade labAO system
  • Optimizing multi-wavelength simultaneous observations
  • Fibers to all telescopes
  • W5 site (1100m)
    • extended/double-pass delay
  • Up to 300 nights over three years of open access time via NOIRLab.

(near future plans)

24

Telescopes & Future plans

24

chara_meeting_2025

By Nic Scott

chara_meeting_2025

  • 58
