National Grid's
Deeside Project

aka OSEAIT (Offgrid Substation Environment for
the Acceleration of Innovative Technologies)

Winner
Electricity Transmission
Network Innovation Competition 2015

....modify an existing 400kV substation into an easily reconfigurable, field trial facility.

....turn a decommissioned substation into a data and information mecca.

The Brief

The Deeside facility will be the first in Europe where assets associated with electricity networks can be tested off-grid, 24 hours, seven days a week.

  • Smart Grid
  • Analytics
    • Big Data
    • Signal Processing
    • Computer Vision
    • Machine Learning
  • ​Industrial IoT
  • XaaS

What the Hell is Smart Grid?

  • Safety
  • Reliability
  • Resilience
  • Efficiency
  • Cost Effectiveness
  • Flexibility

Volume

  • Terabytes
  • Records/Arch
  • Transactions
  • Tables, Files

Veracity

  • Trustworthiness
  • Availability
  • Accessibility

Variety

  • Structured
  • Unstructured
  • Multi-factor
  • Probabilistic

Value

  • Correlations
  • Predictions

Velocity

  • Batch
  • Real/near-time
  • Processes
  • Streams

Reference: IoT World Forum

The Power of IoT

Collaboration & Processes
(Involving People & Business Processes)

Application
​(Reporting, Analytics, Control)

Data Abstraction
​(Aggregation & Access)

Data Accumulation
​(Storage)

Edge Computing
​(Data Element Analysis & Transformation)

Connectivity
​(Communication & Processing Units)

Physical Devices & Controllers
​(The "things")

The Position

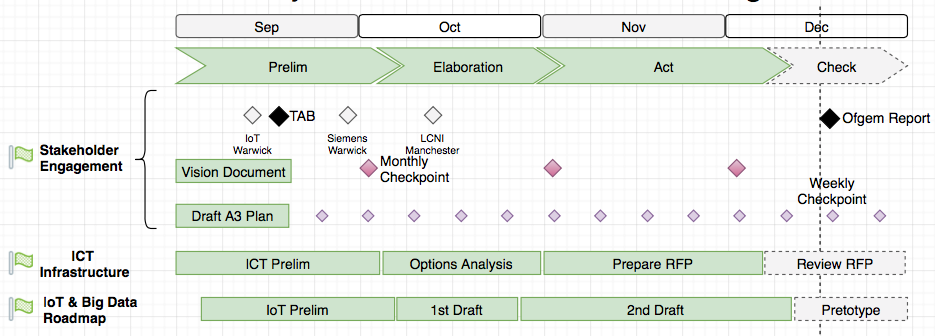

Highlights June to December 2016

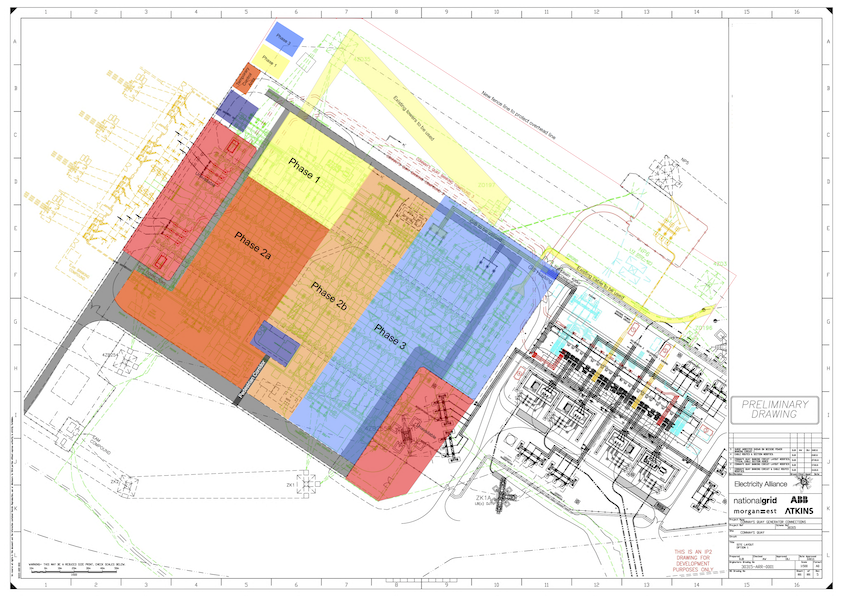

  • 15.5 Acres
  • Substation
  • Overhead Line
  • Underground Cable Sections
  • Workshops
  • Storage Space
  • Office Block

Phase 1

Unavailable

Phase 2

Phase 3

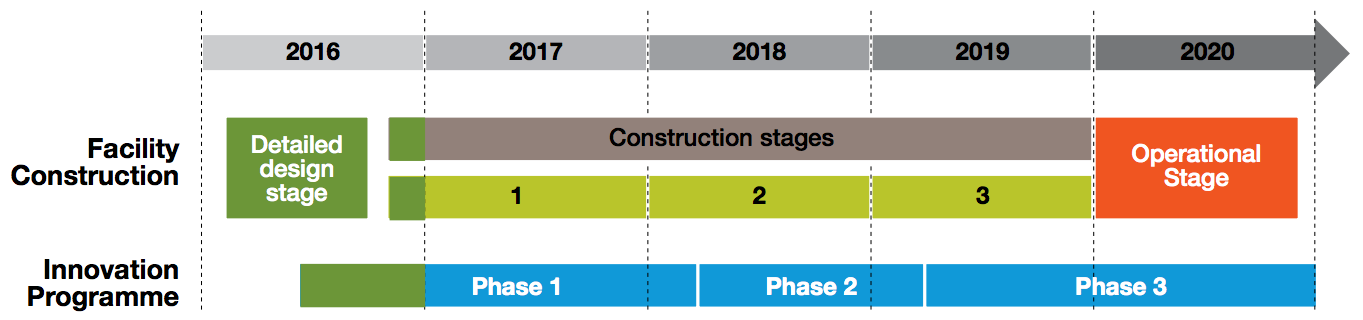

Analytics  Roadmap

  1. New Technology from LNO or Manufacturer.
  2. Legacy assets with unknown condition and capability.
  3. Develop & test new operating regimes.

Business Scenarios

The IoT & Big Data solution should be able to support these scenarios and some more.

  • Multiple projects and suppliers or GB network owner’s onsite at the same time
  • A single very large project requiring capability from most of the facility
Project Sponsor Status
Weather Station Neil Williams Alpha
Overhead Lines David Scott Beta

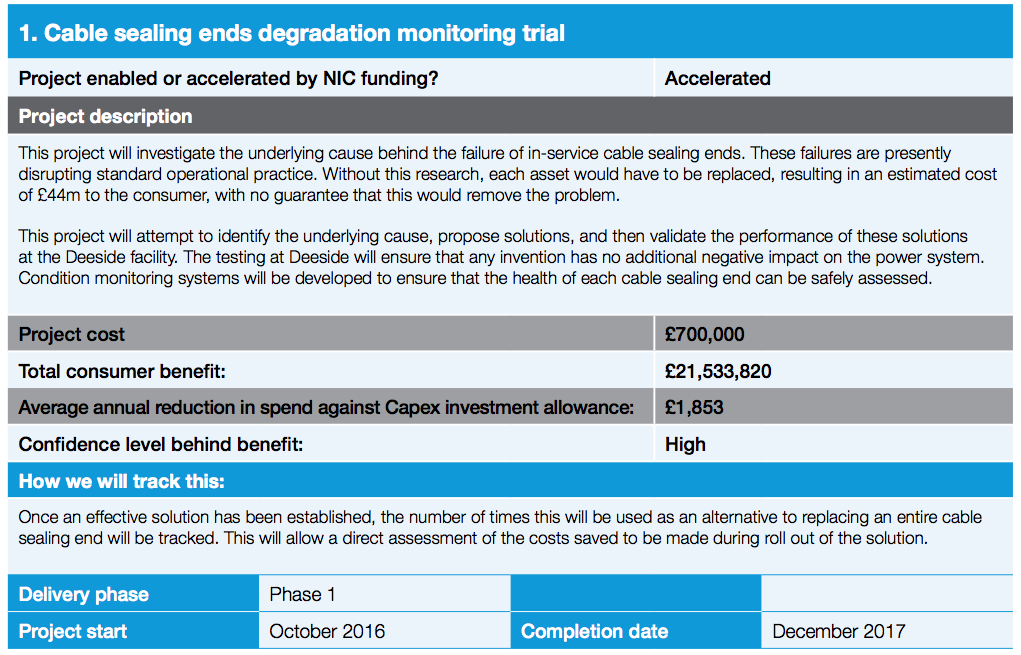

Cable Sealing Ends Andy Ross Pilot

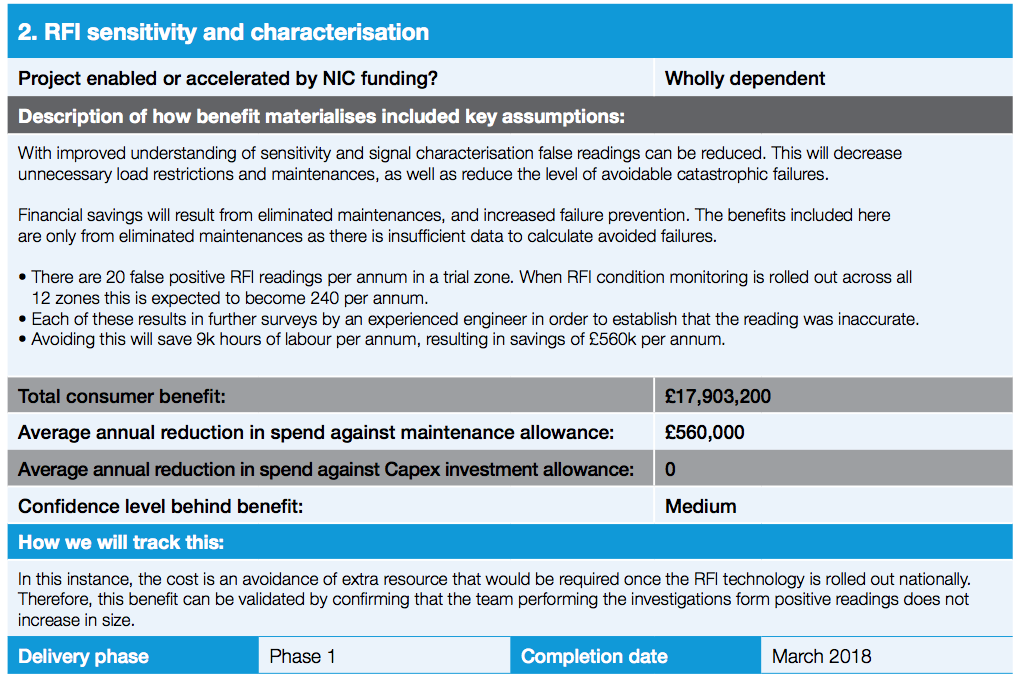

RFI Sensitivity   "           " Pilot
Line Scout   "           " Someday Maybe
Conductor coating systems   "           " Someday Maybe
Texture composite insulators   "           " Someday Maybe

Analytics Pipeline

HV Line Monitoring

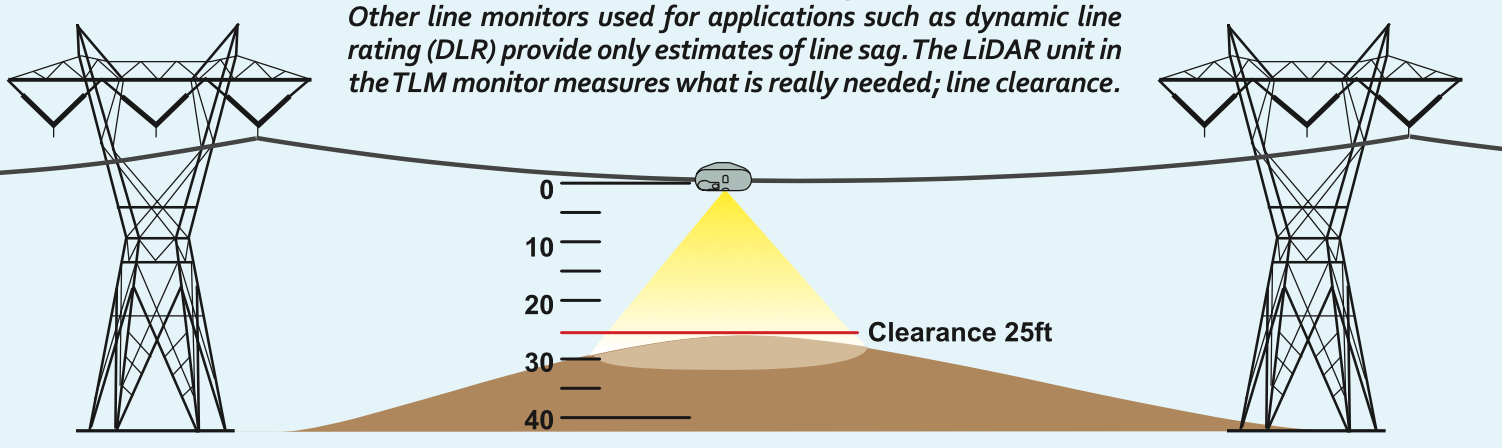

Source: Lindsey

Know the true facility capacity rating of lines by monitoring:

  • the operating temperature of conductors.
  • the distance to the nearest object below.



HV Line Monitoring

  • Increase transmission capacity
  • Defer investments
  • Improve grid resiliency

Weather Station

Environmental monitoring will be a key consideration for most Deeside projects.

  • Temperature
  • Atmospheric pressure
  • Humidity
  • Wind Speed
  • Solar Radiation
  • Aggregate Precipitation
  • Falling Precipitation
  • Drop size distribution
  • Visibility
  • Cloud ceiling

Buy

Borrow

Build

Prediction

Source: Wikipedia

Detection

Focus on electrostatic field (the energy field of which thunderstorms are composed).

Focus on electromagnetic field (the field that is affected by a lightning discharge)

National Grid's Deeside Project

By TILIX

National Grid's Deeside Project

In November 2015 NG won the Electricity Network Innovation Competition for its submission of a plan to “modify an existing 400kV electricity substation into a field trial facility to host electricity related innovation projects in a live substation environment".

  • 2,744
