Machining metre-sized gratings with nanometre accuracy
We aim to make large diffraction gratings
Grating requirements
Up to 1.6m x 0.3m in size

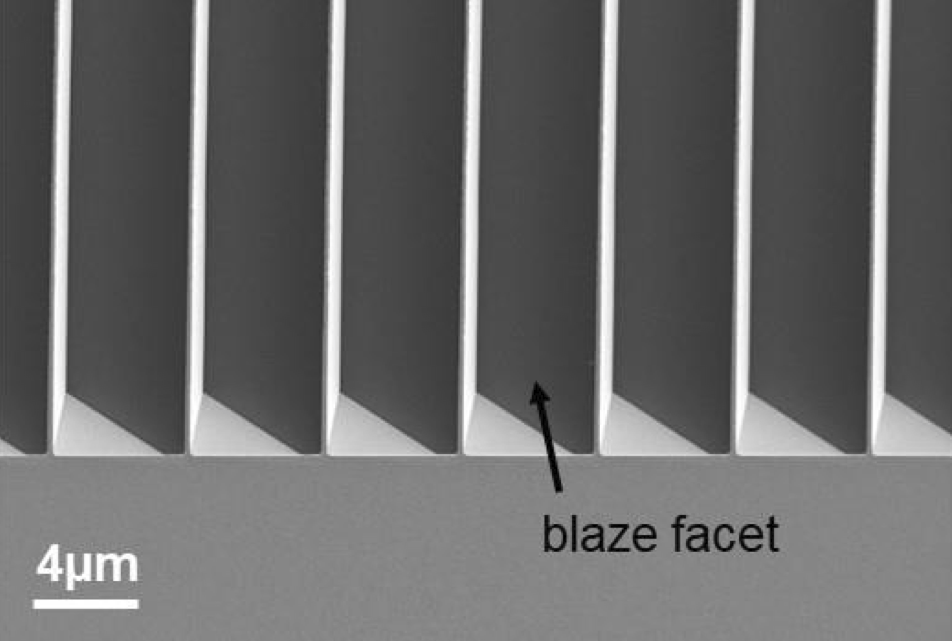

Random error in groove position < 15nm
Cyclic errors < 1nm

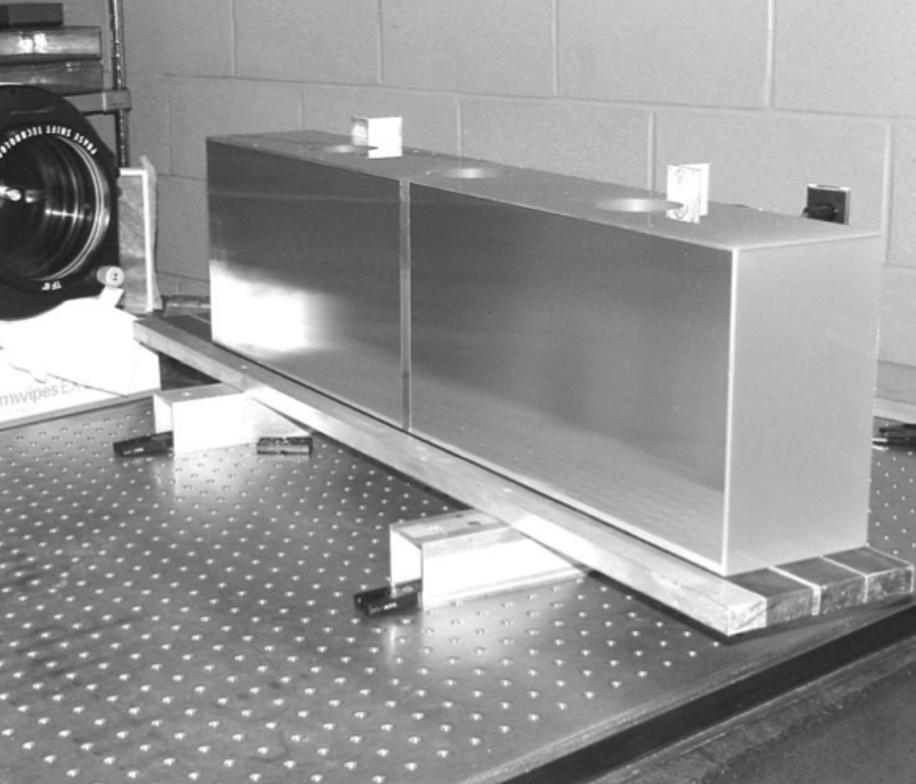

Based on wet-etching of silicon

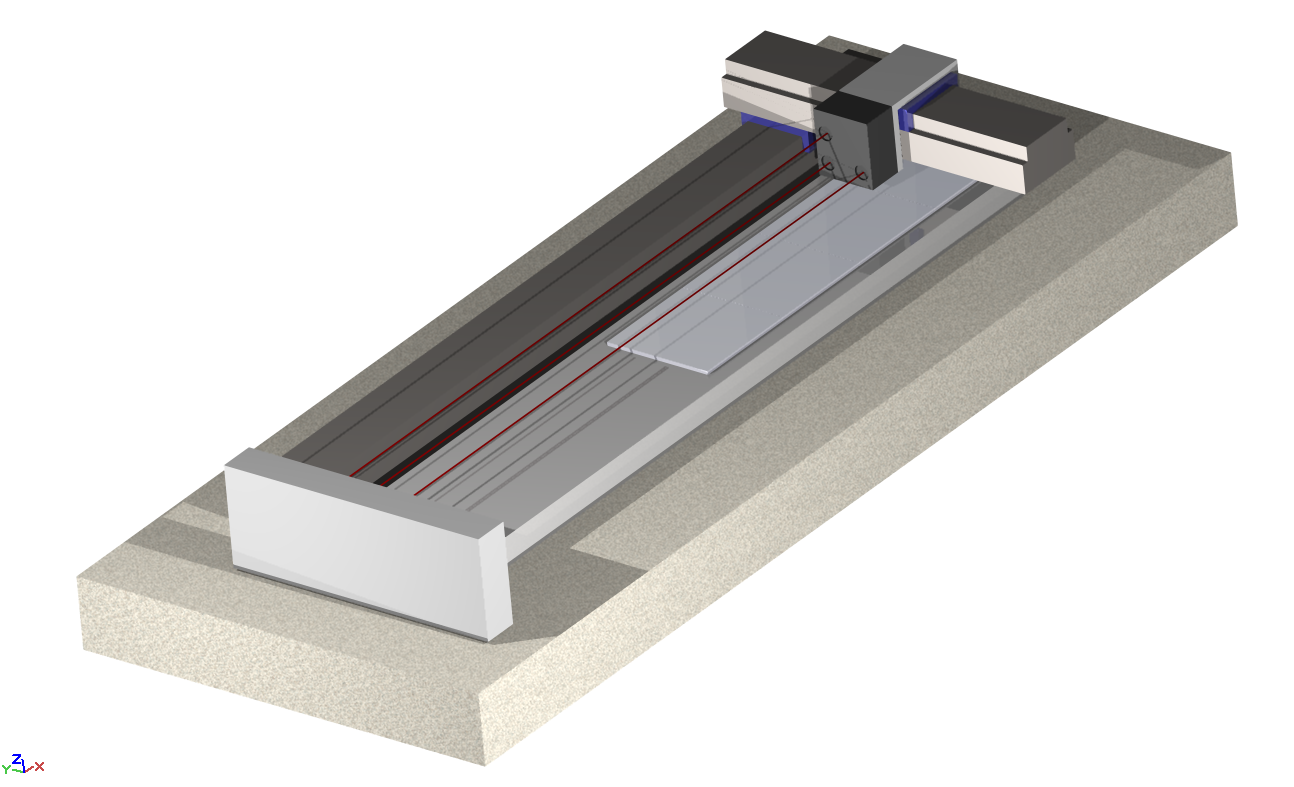

Overall concept
Concept sketch

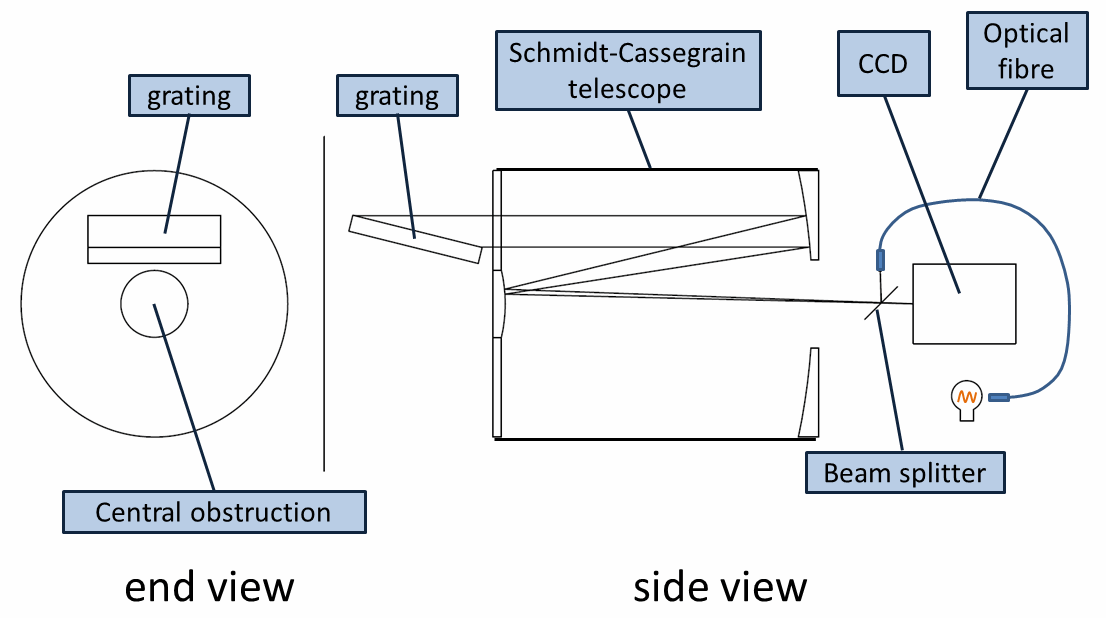

Testing gratings optically

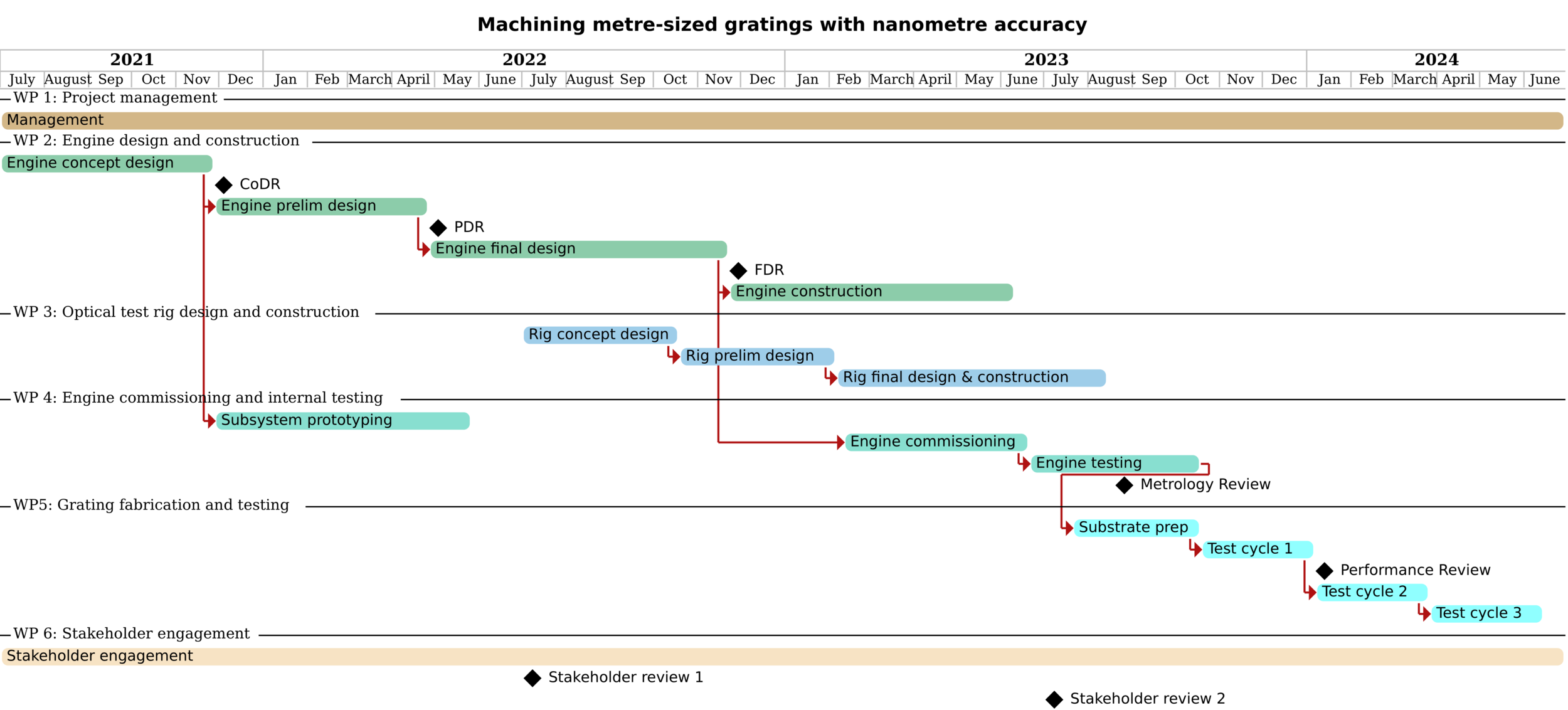

Original timeline from grant proposal
Manufacturing metre-sized gratings 2022-10
